Finished Arden & Oak garden room at night with LED-lit soffit and corner glazing
Gallery · Build Diary

Built properly, step by step.

A real Arden & Oak timber-frame build, photographed on site in the order it happened — from a bare patio to a finished room.

Stage 01

Setting out & base

Every build starts square and level. The perimeter is set out, damp-proof course laid beneath every timber, and the floor frame packed level on adjustable supports.

Setting out the footprint

Perimeter timbers are positioned and checked for square, with DPC tape laid ready beneath the frame. The surrounding patio is sheeted to protect it throughout the build.

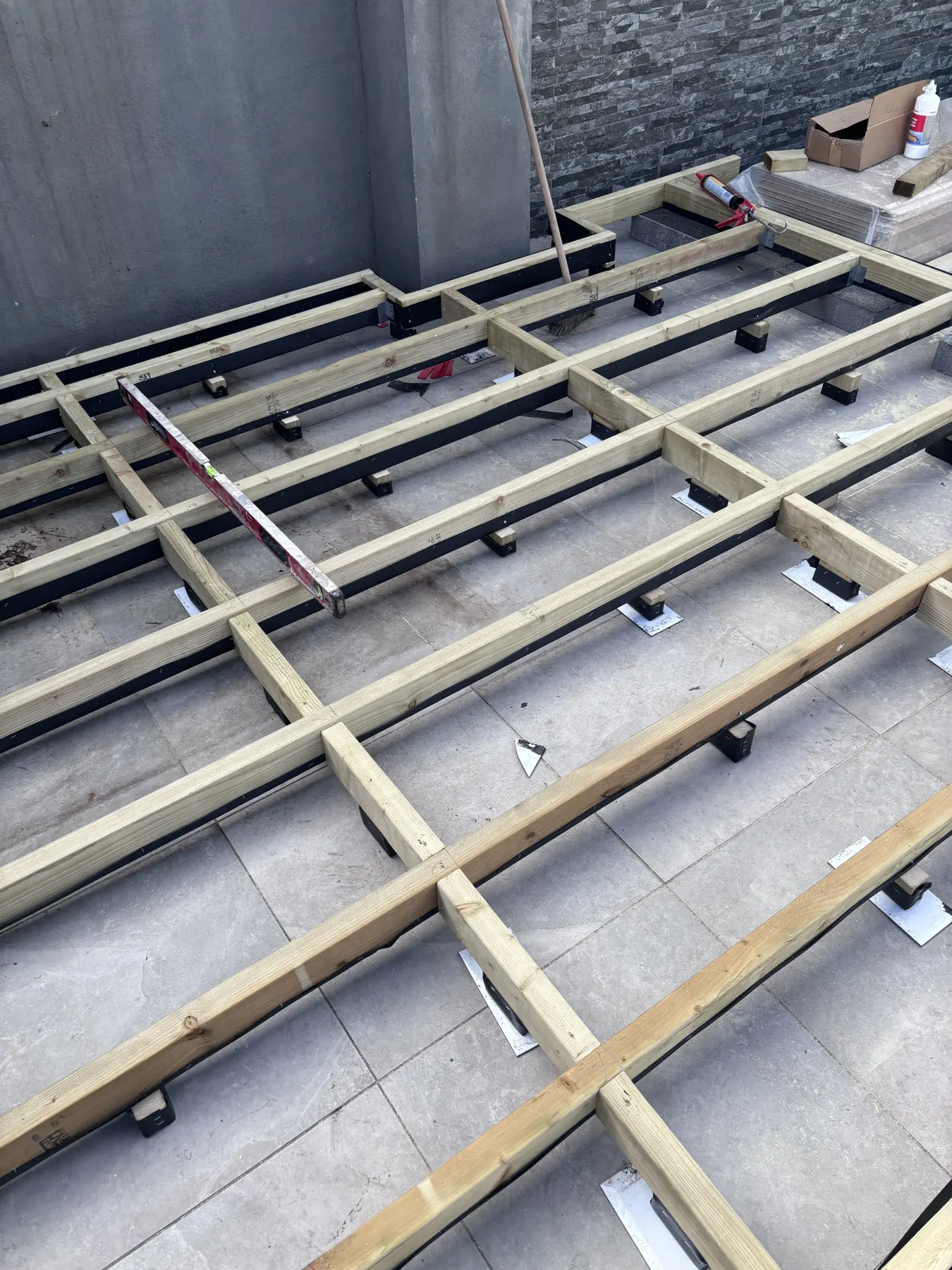

C16 floor joists & noggins

Pre-treated C16 joists and cross-noggins are fixed into a rigid grid, each one sitting on DPC over adjustable supports so no timber touches the ground.

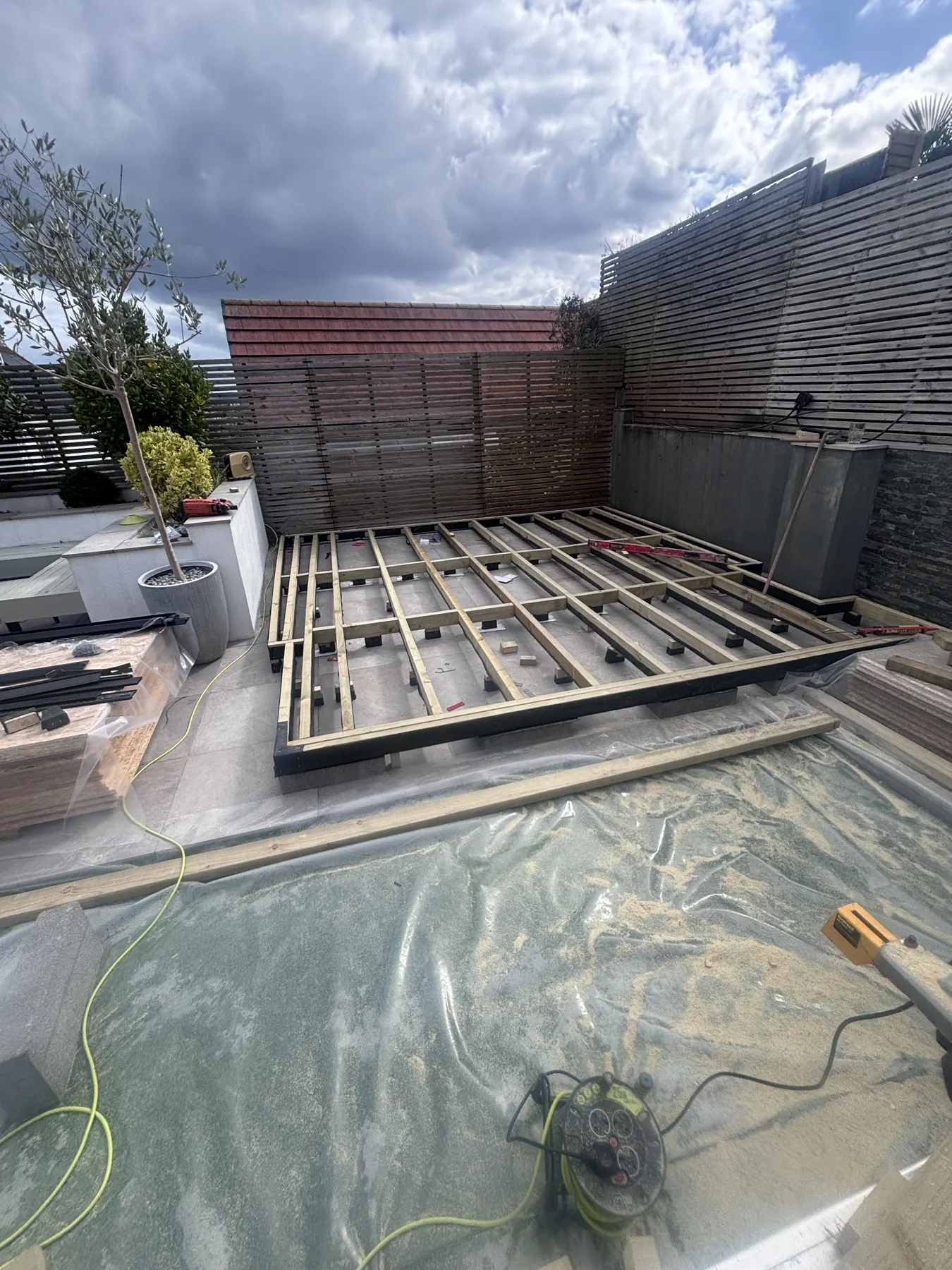

Floor frame levelled

The complete floor frame, laser-levelled across its full width before any insulation goes in — the base everything else is built square from.

Stage 02

Insulated floor

The floor is built as a warm, sealed platform: PIR insulation between the joists, a vapour control layer, then a moisture-resistant structural deck.

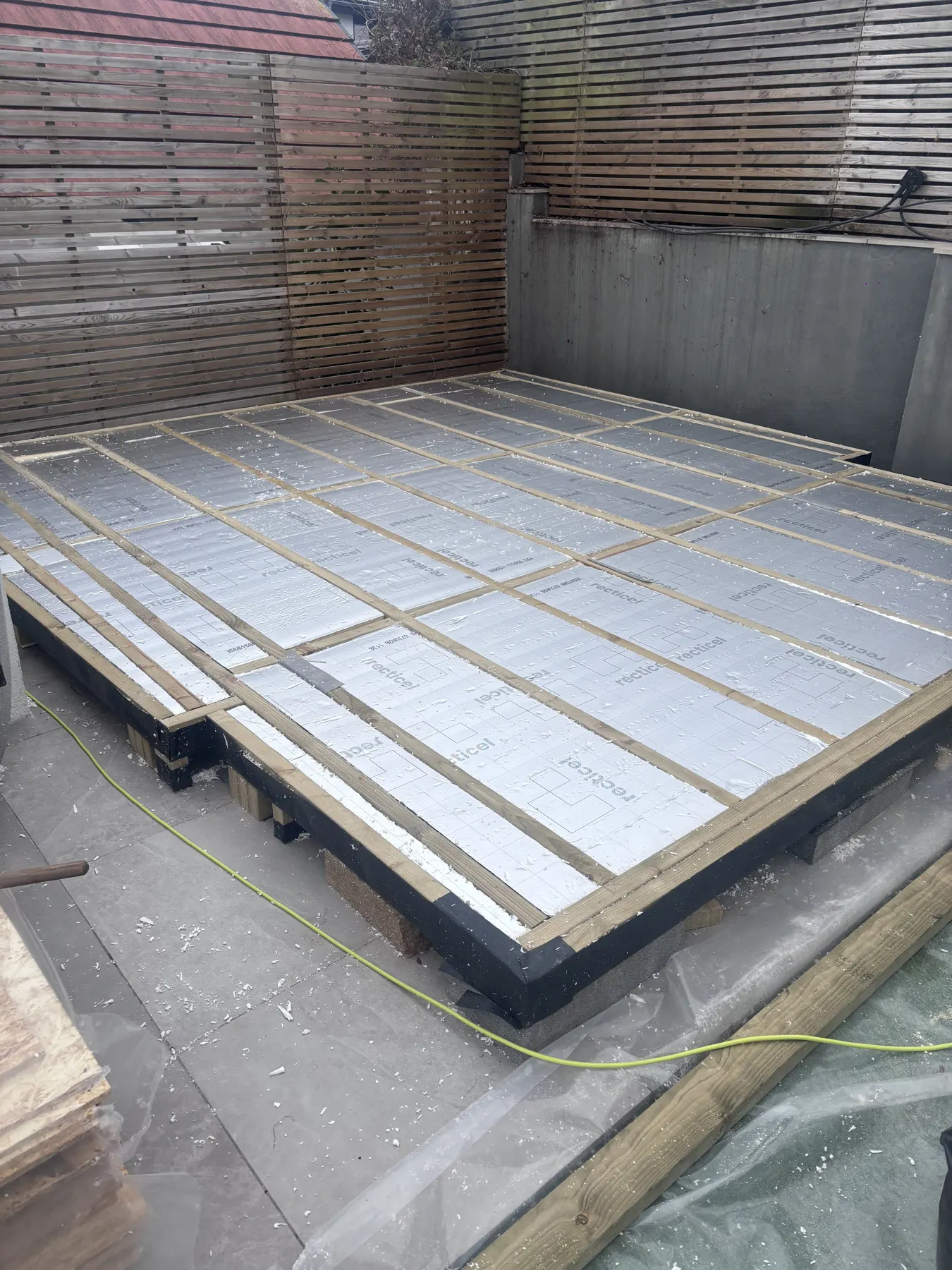

PIR insulation between joists

Rigid PIR boards are cut tight between every joist and the joints taped, so the floor stays warm underfoot all year round.

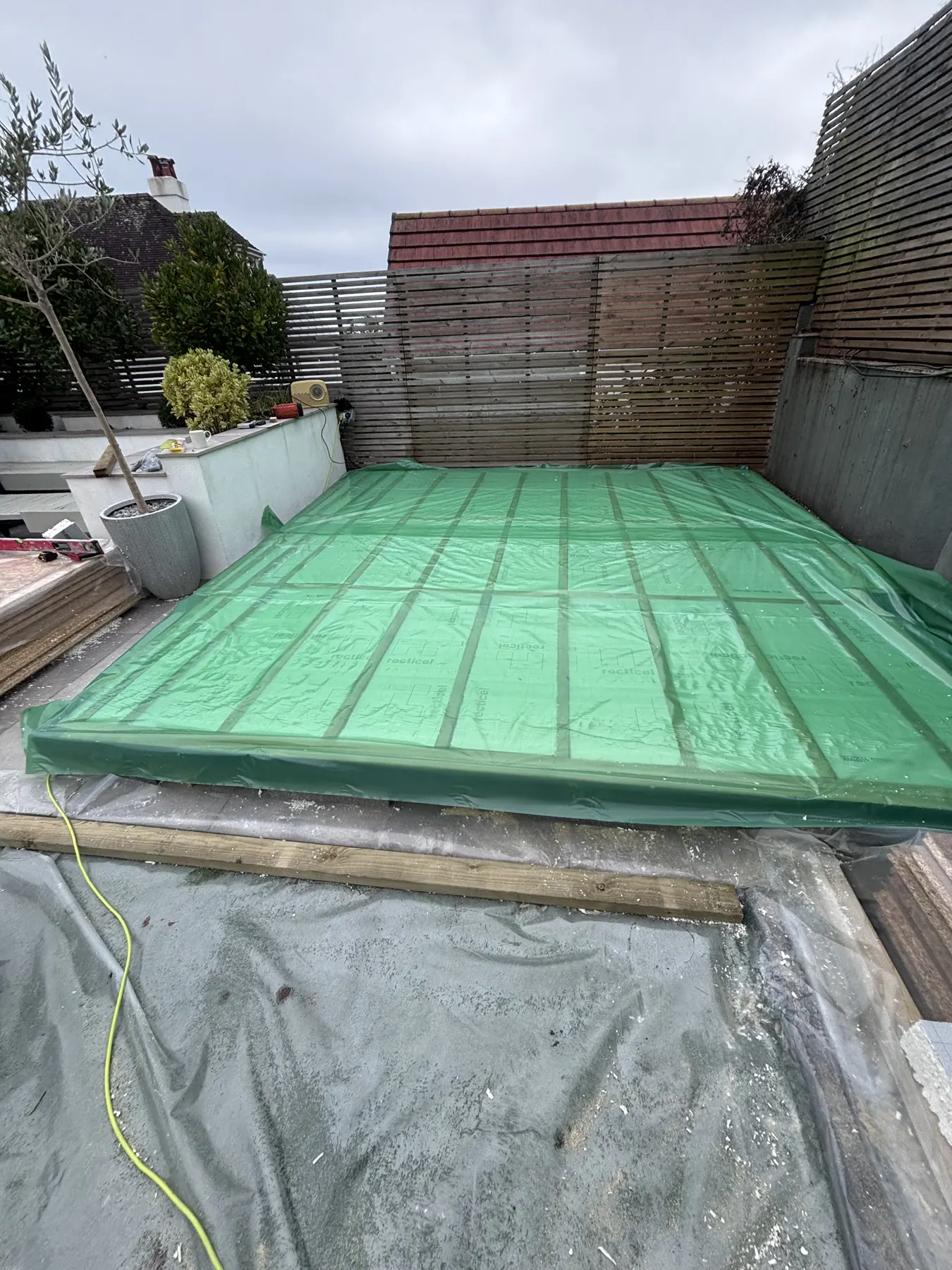

Vapour control layer

A continuous vapour control layer is laid over the insulated frame and lapped at the edges, keeping moisture out of the floor build-up.

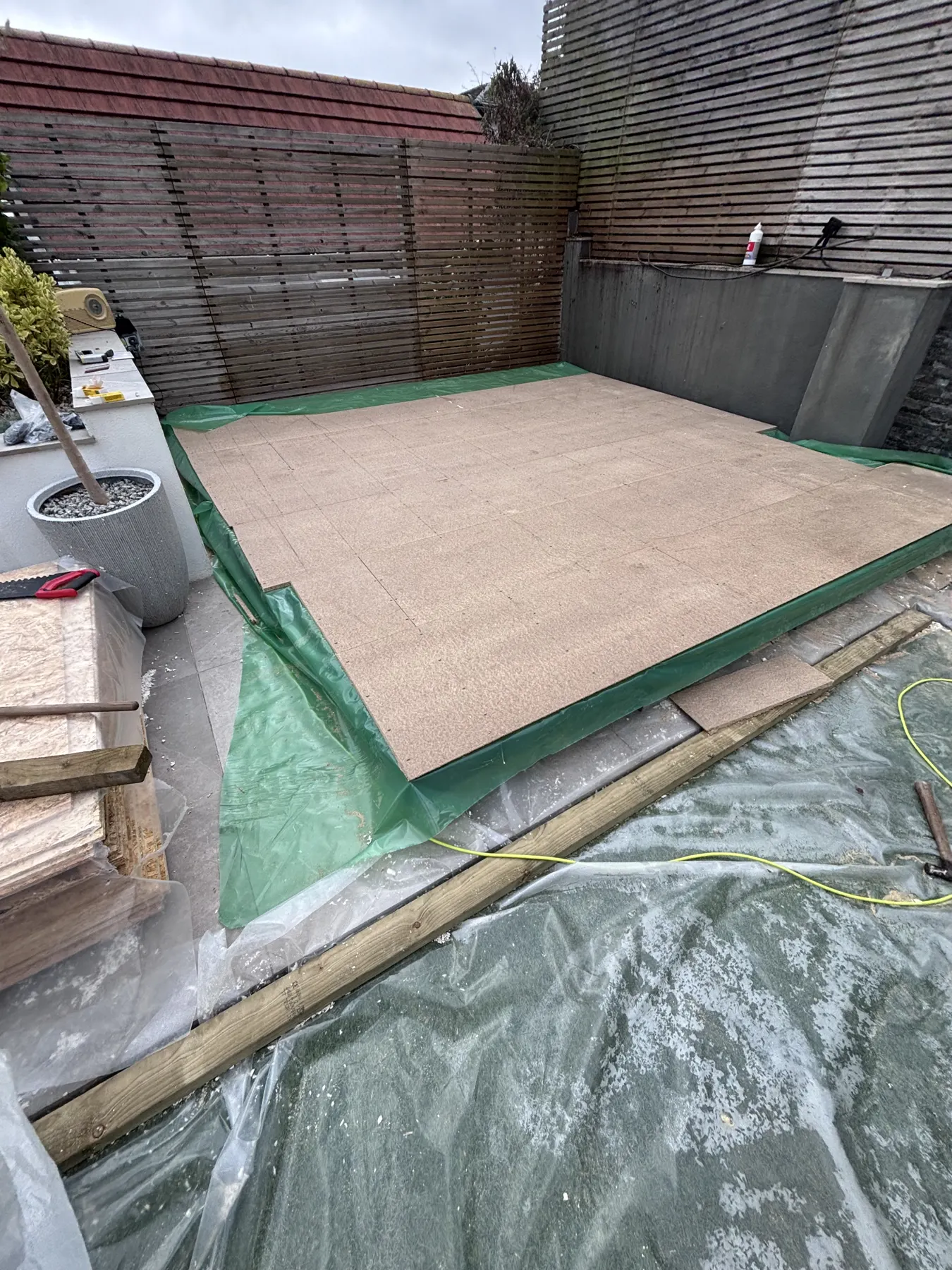

18mm moisture-resistant deck

Tongue-and-groove moisture-resistant chipboard is glued and screwed over the whole floor, giving a solid platform to build the walls on.

Stage 03

Walls & weather envelope

Wall frames are built on the deck and raised into place. OSB sheathing adds rigidity, then a breather membrane and battens form the ventilated cavity behind the cladding.

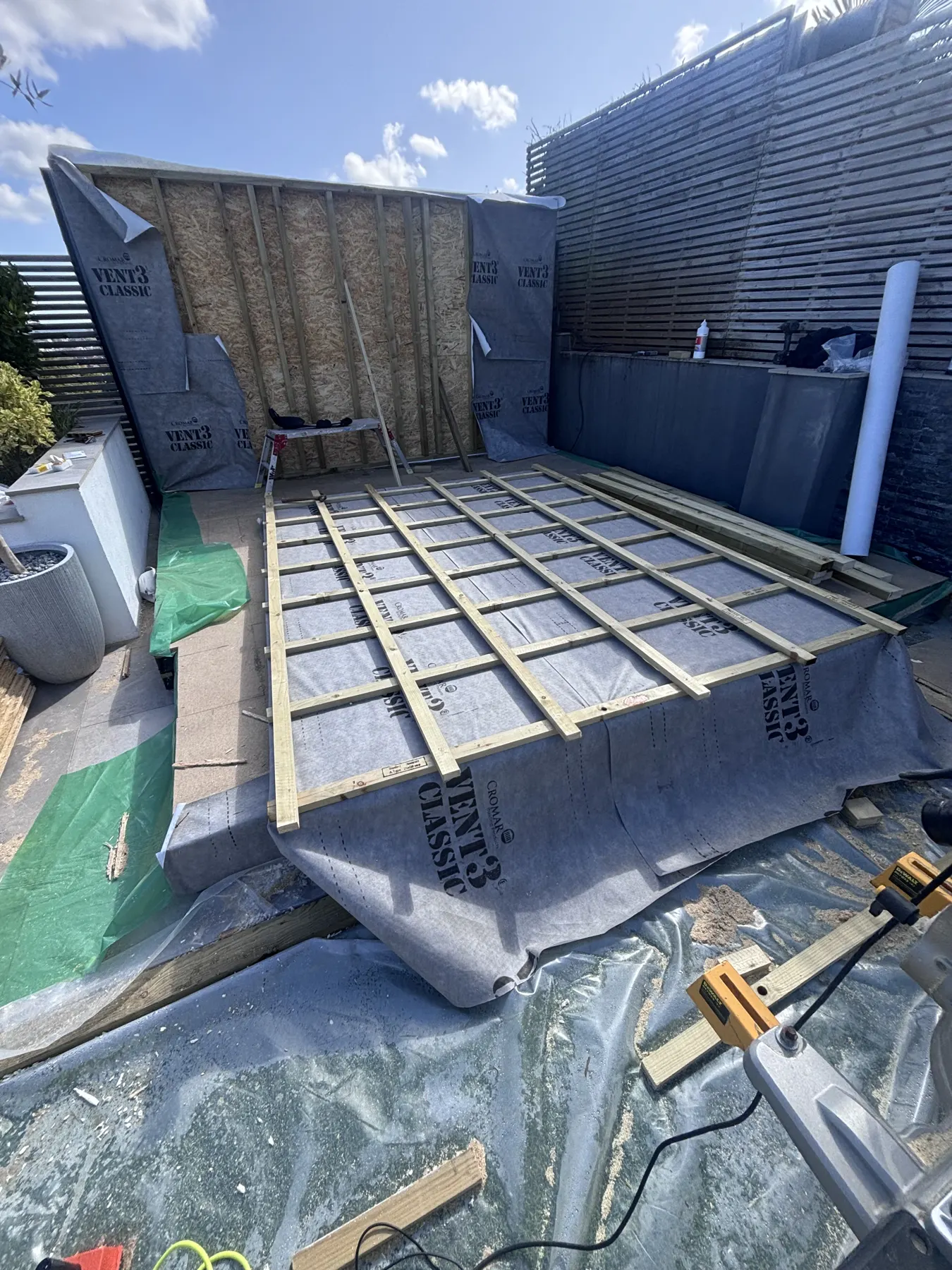

Walls raised & wrapped

The rear wall stands sheathed in OSB while the next frame is wrapped in breather membrane and battened on the deck — ready to be lifted into position.

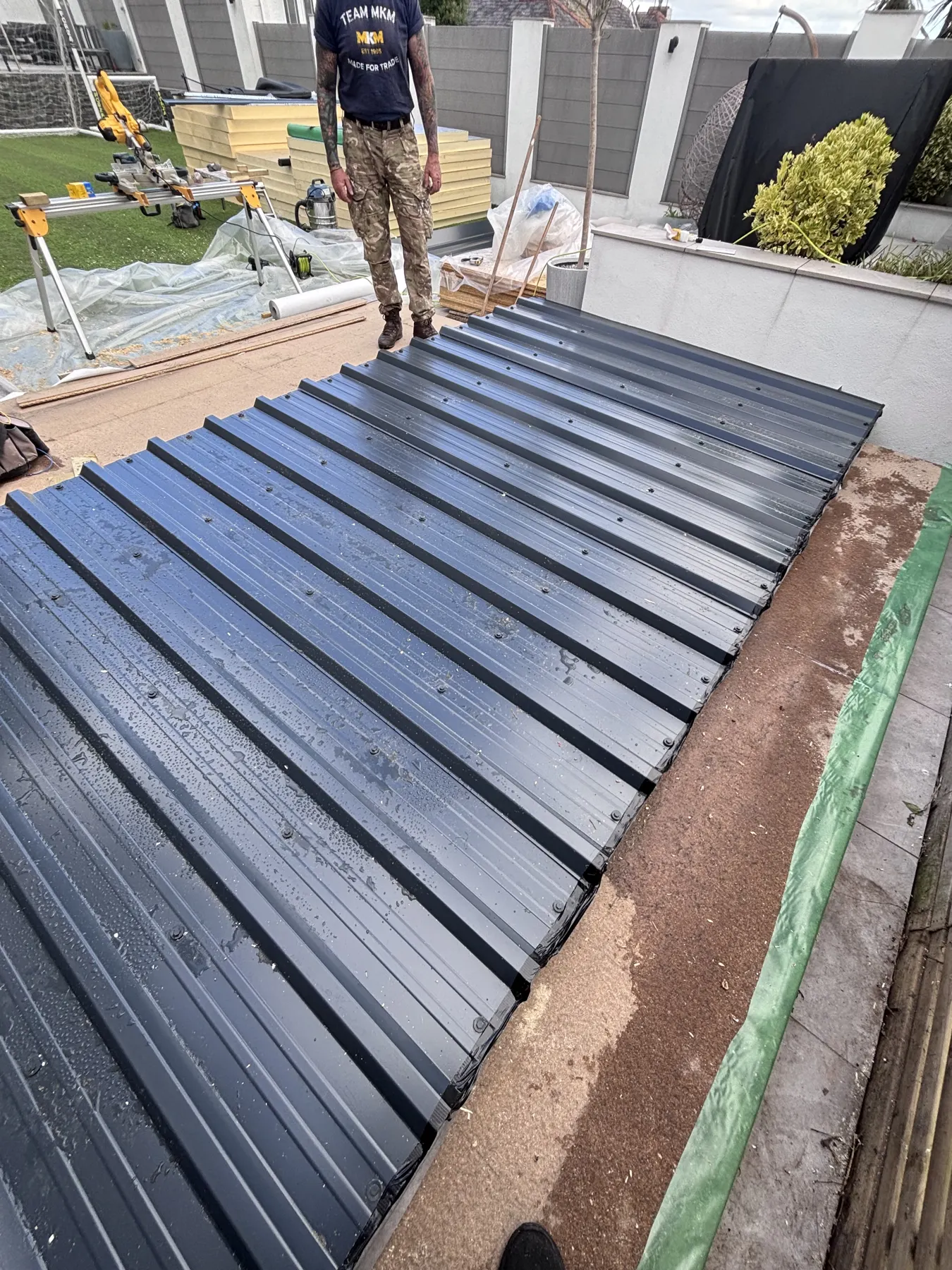

Steel sheeting prepared

Anthracite profiled steel sheets are cut to length and pre-drilled on site, ready to be fixed to the frame.

Frame up & battened

The full structure stands with the roof on, walls wrapped in breather membrane and battened out to form the ventilated cavity behind the cladding.

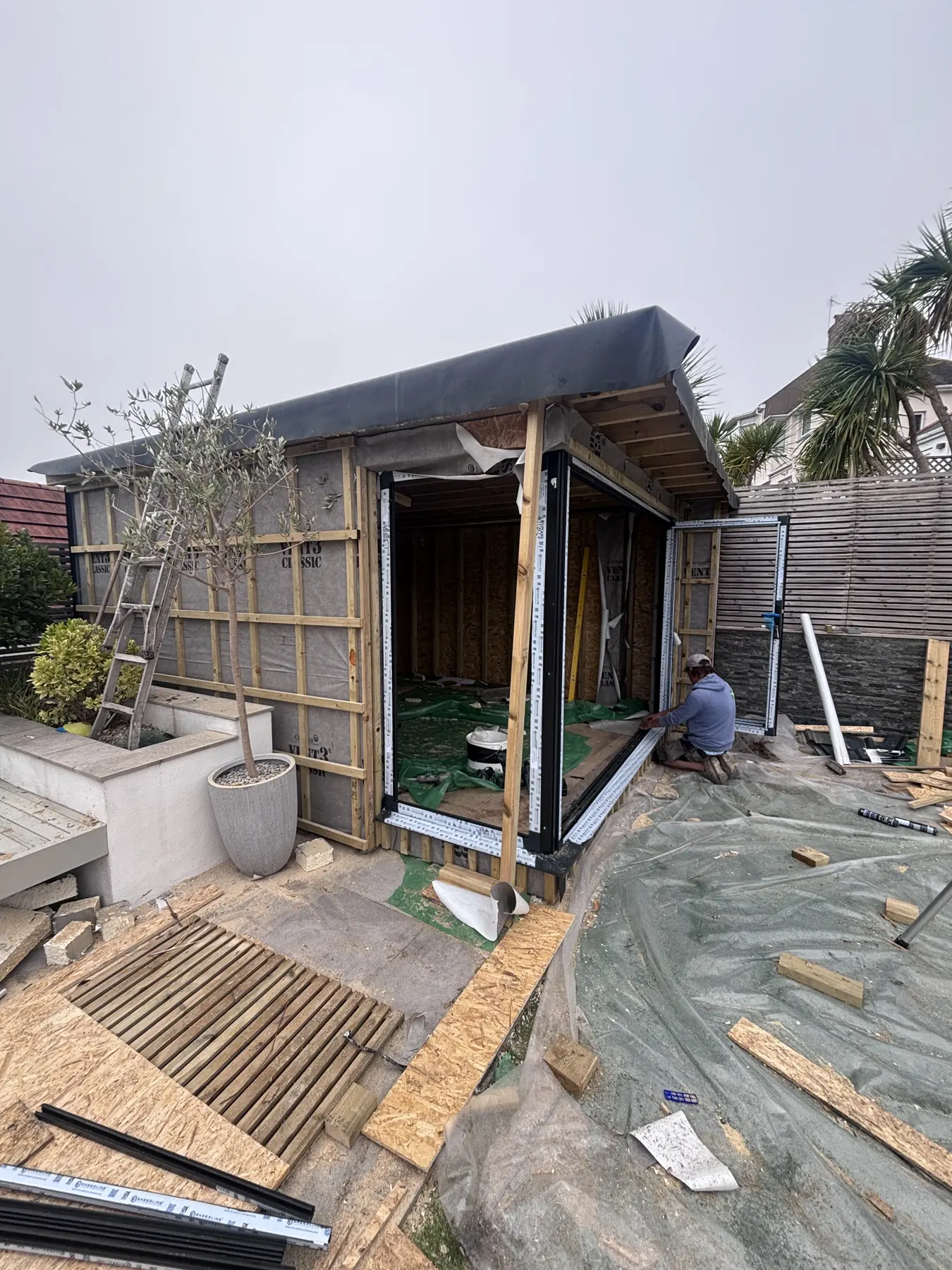

Door frames going in

Glazing frames are fitted into the prepared openings, packed and fixed square before the glass panels are hung.

Stage 04

Roof & glazing

With the frame weathertight, the EPDM roof is laid in a single sheet and the glazing is installed — the room is now sealed against the weather.

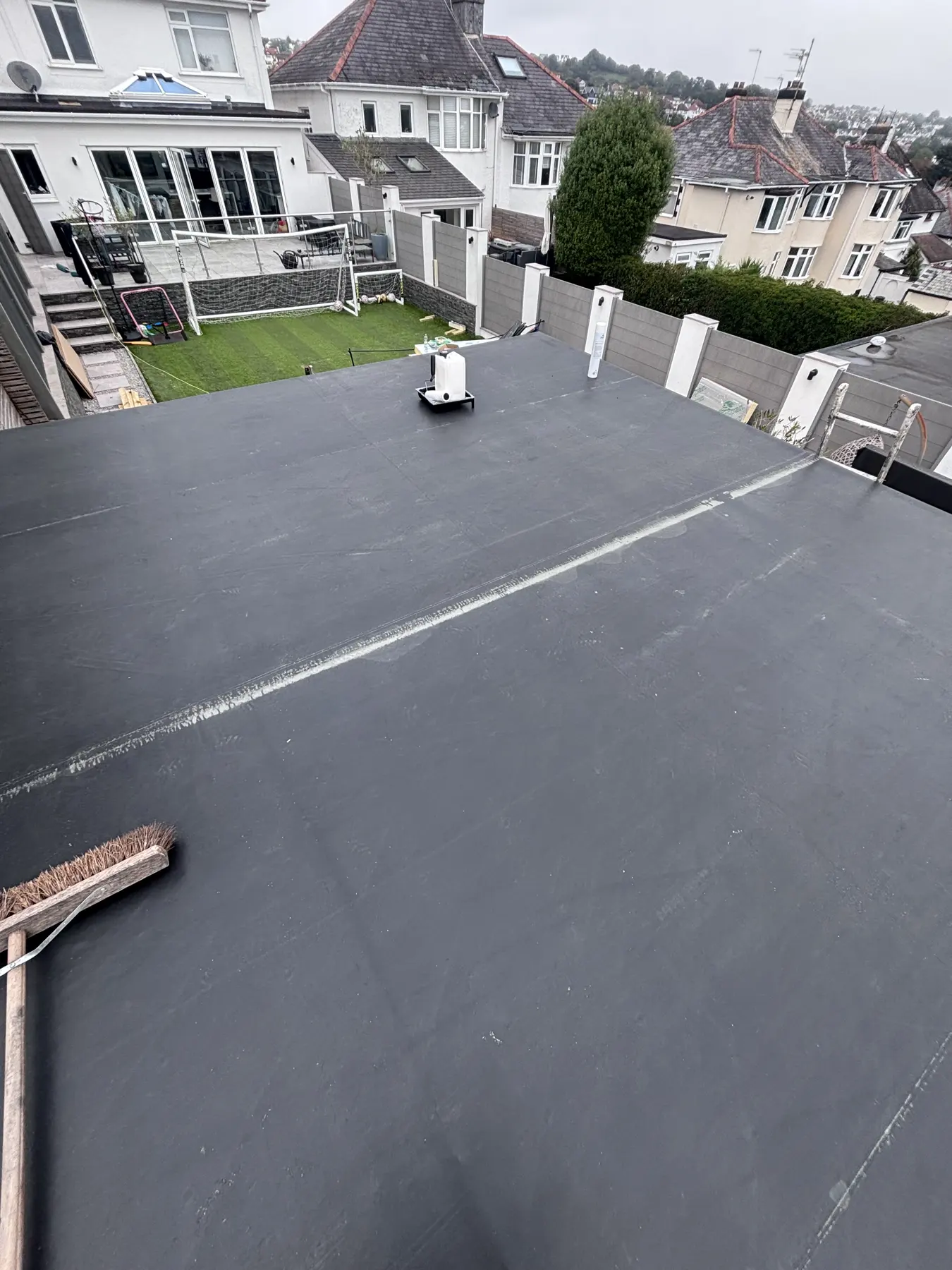

EPDM roof membrane

A single-ply EPDM rubber membrane is bonded over the 18mm OSB roof deck — one continuous sheet with no joints for water to find.

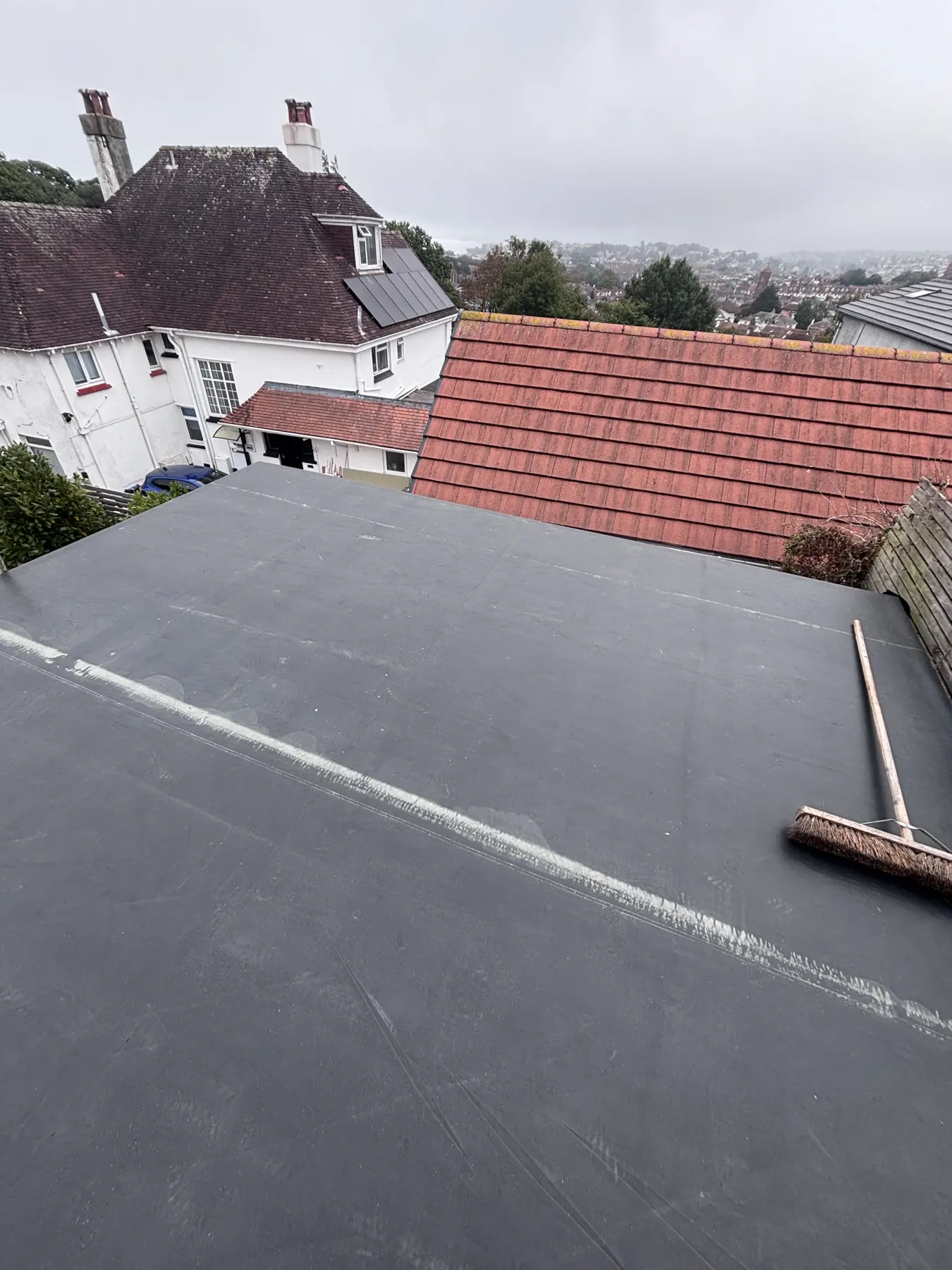

Roof trimmed & sealed

The membrane is rolled out, trimmed and dressed to the edges ready for the trims, leaving a clean, watertight roof.

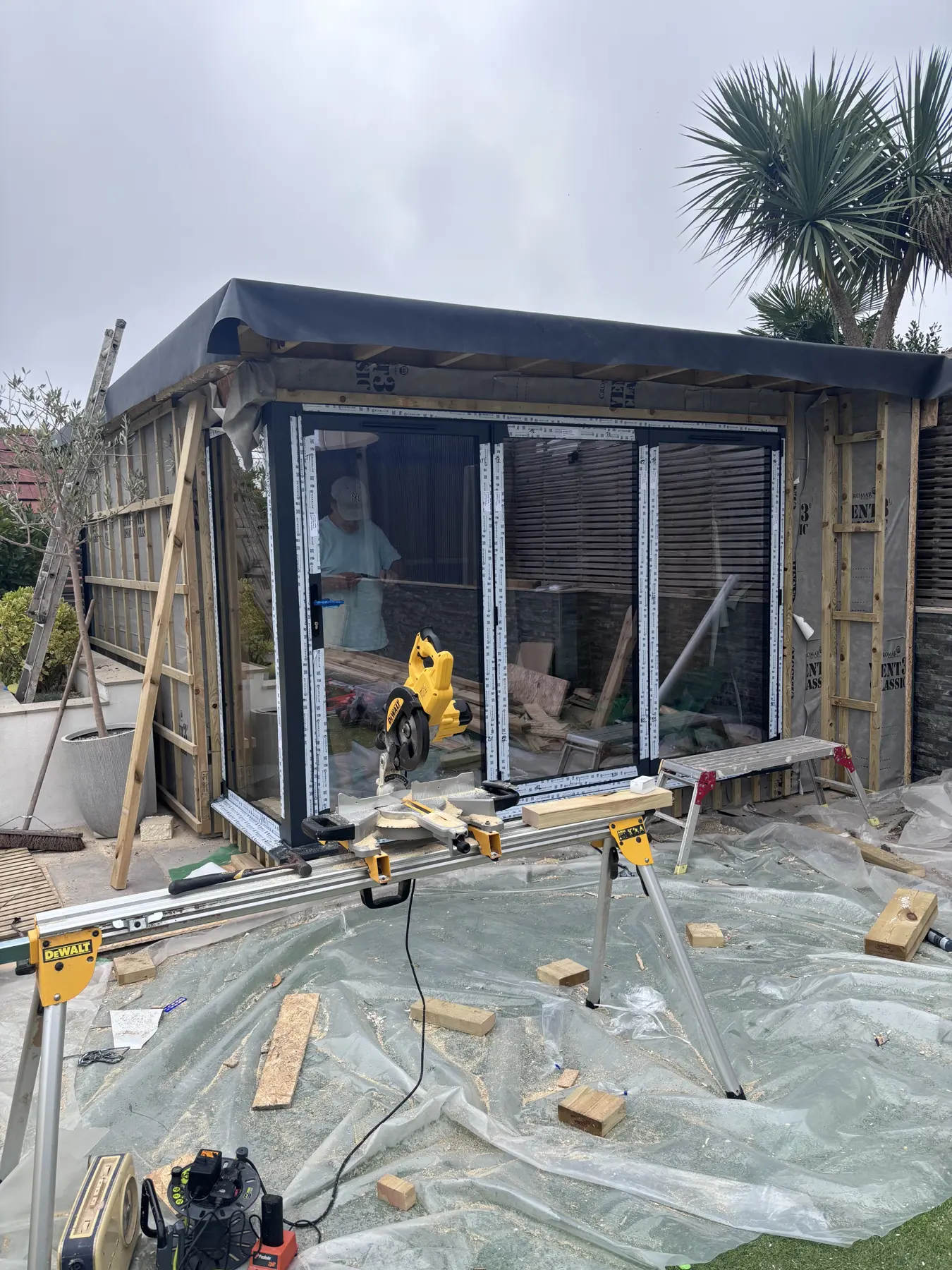

Glazing installed

The corner glazing is in, closing up the front of the room and bringing the garden right inside.

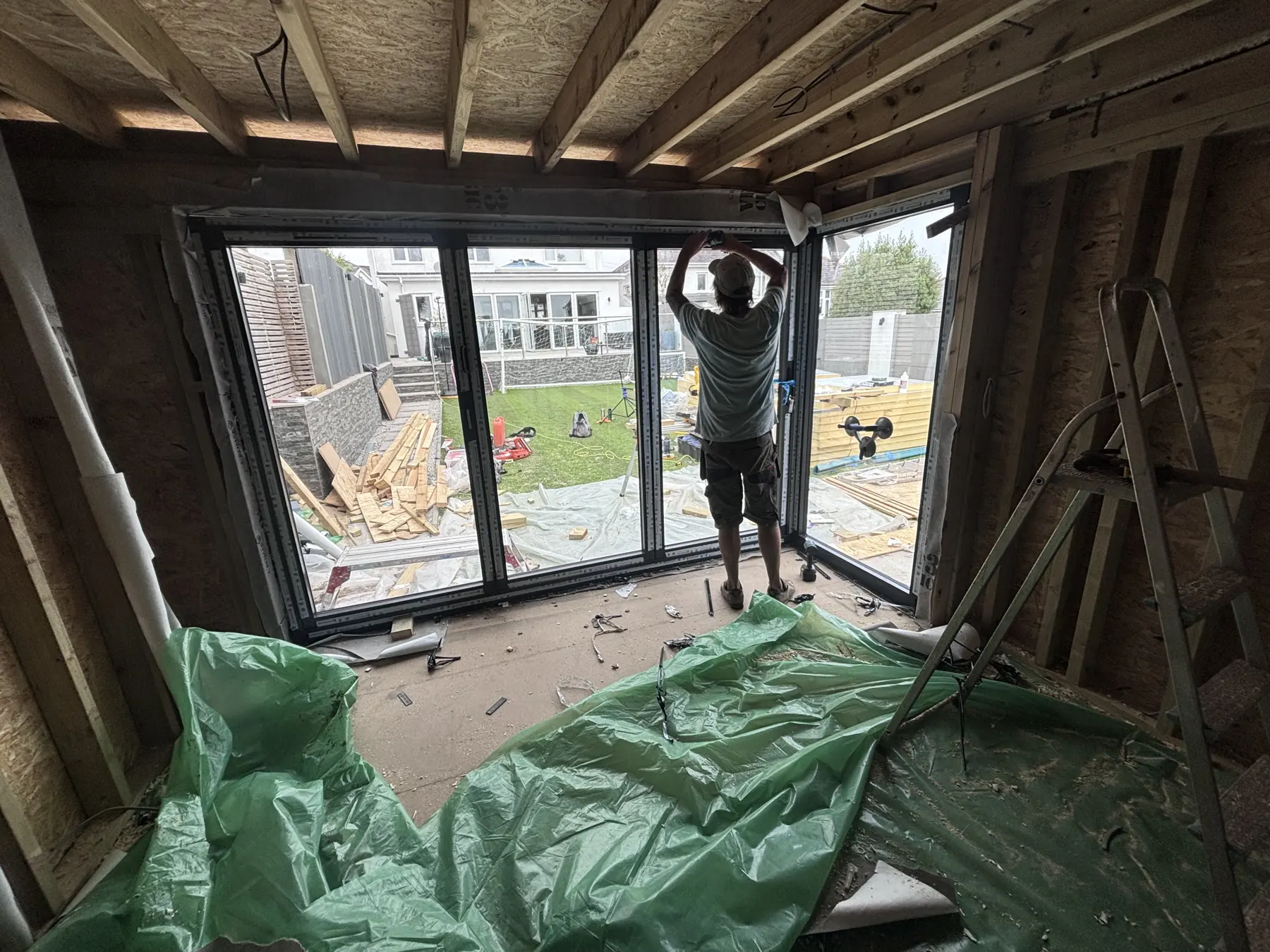

Glazing from the inside

Final adjustments are made from inside, with the floor still protected and the frame ready for insulation.

Stage 05

Insulation & airtightness

Rigid PIR insulation is cut tight between every stud and rafter, then the whole inside is wrapped in a vapour control layer so the room stays warm and dry.

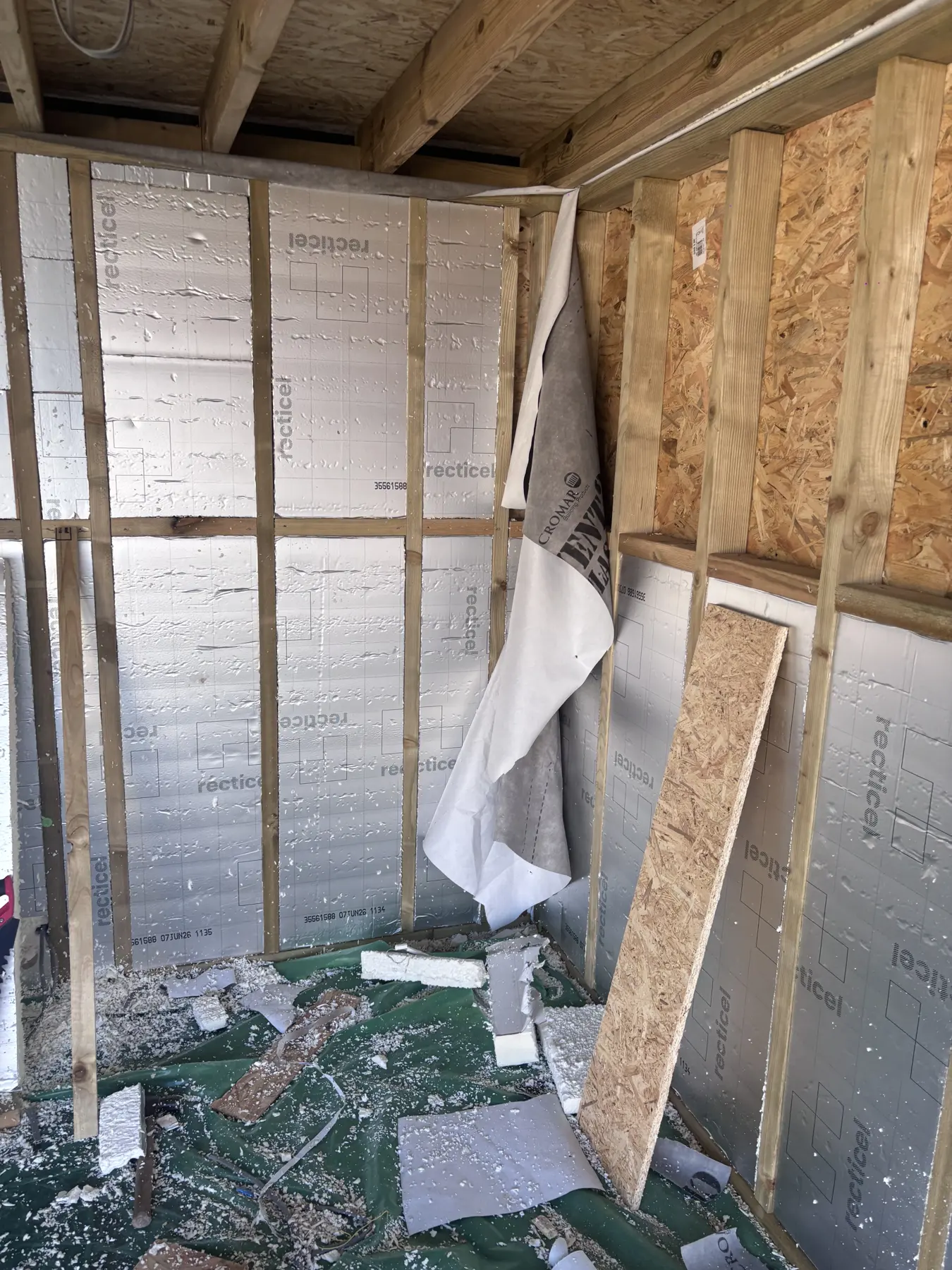

90mm PIR between studs

PIR boards are friction-fitted between the C16 studs, wall by wall, with the joints taped to stop cold spots.

Walls & ceiling insulated

Every wall is now fully insulated, with cable runs for the electrics in place and the 90mm PIR roof insulation going in between the rafters.

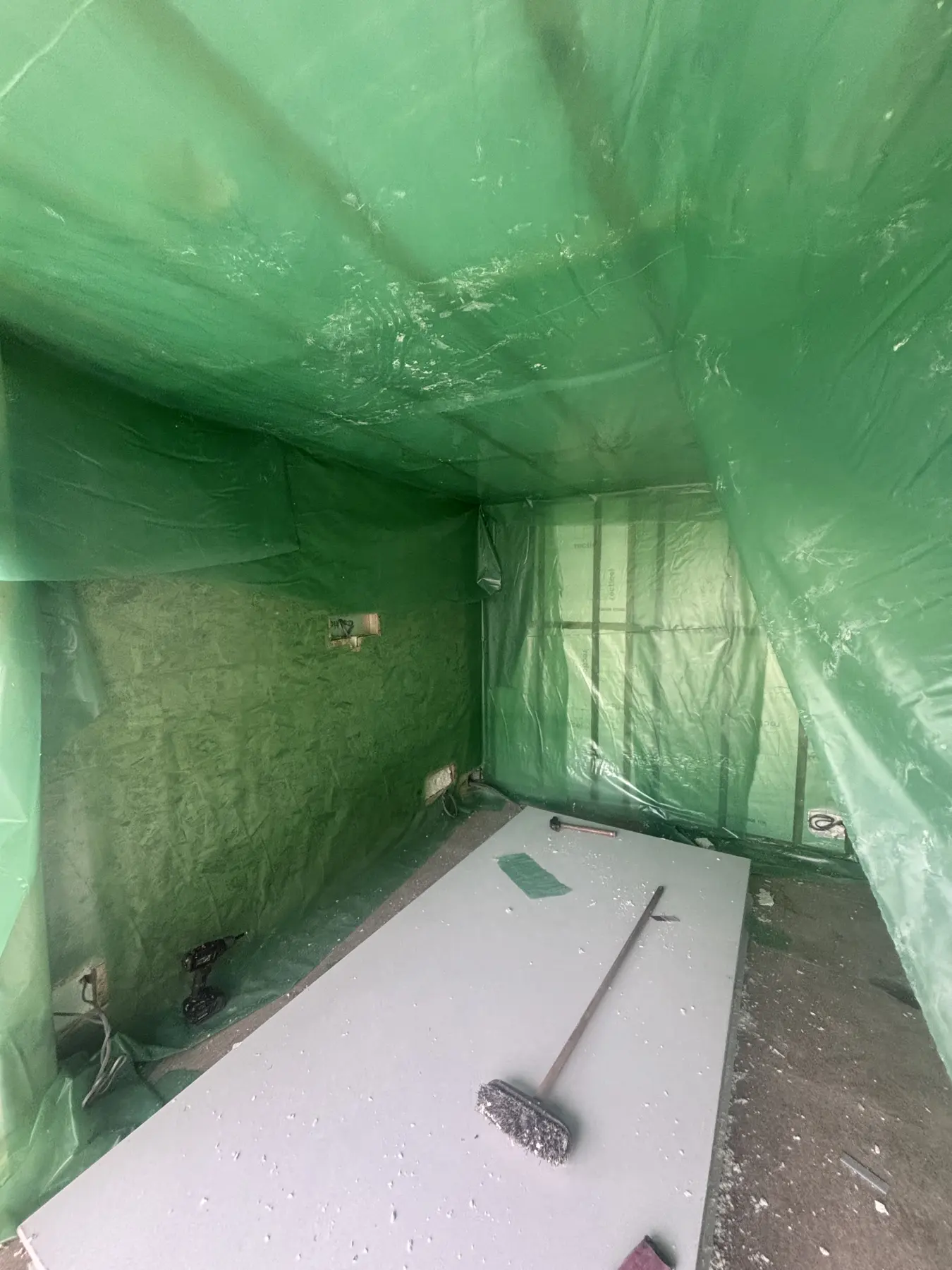

Vapour control layer fitted

A continuous vapour control layer is stapled over the walls and ceiling and taped at every lap, sealing the insulation from moisture inside the room.

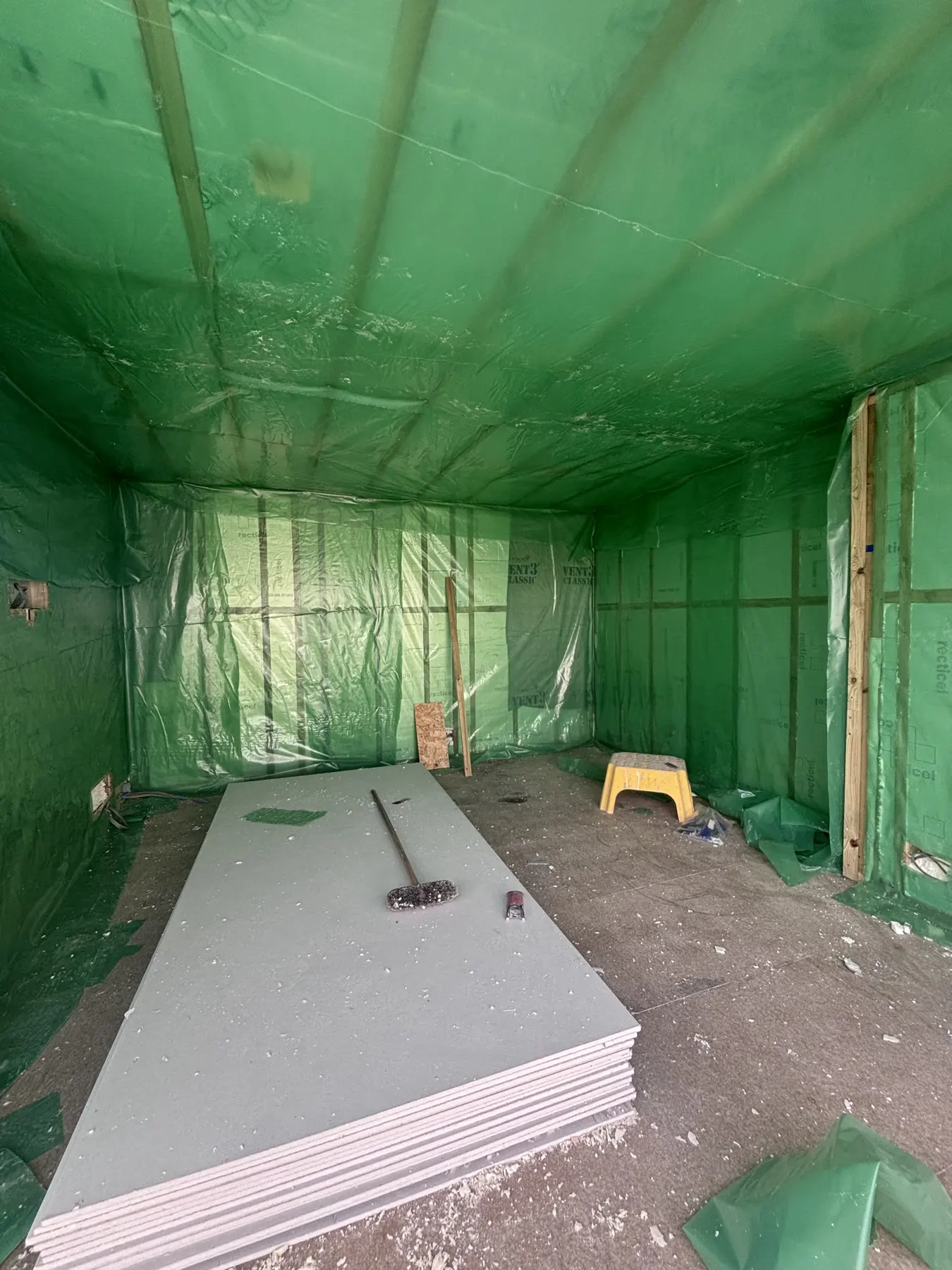

Sealed & ready to board

The whole room is wrapped and sealed, with plasterboard stacked and ready to go up.

Stage 06

Boarding out

Plasterboard goes up on the ceiling first, then the walls, giving a solid, crisp interior ready for a hand-skimmed plaster finish.

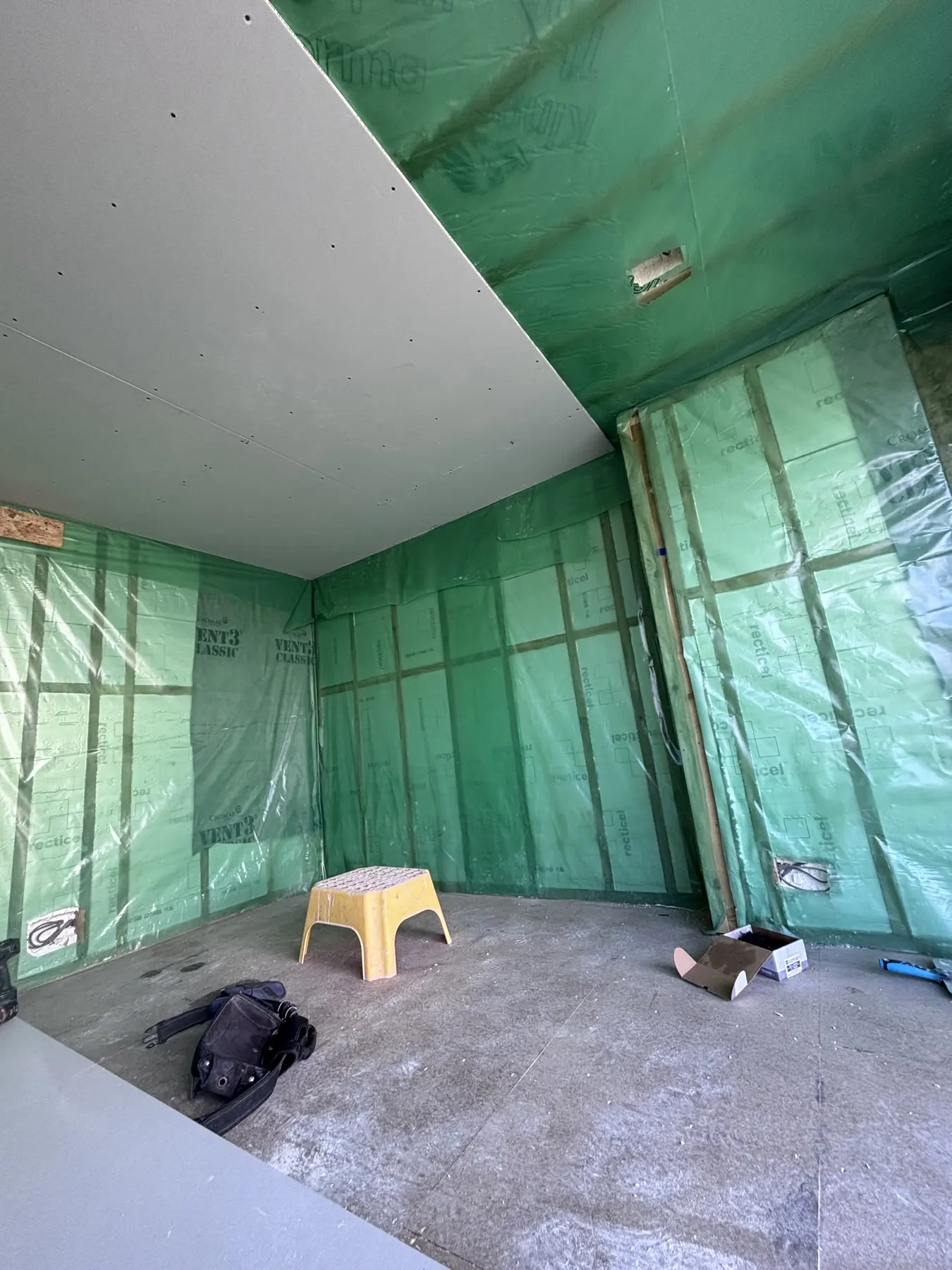

Ceiling boards going up

The ceiling is boarded first, each sheet lifted and screwed to the rafters over the vapour control layer.

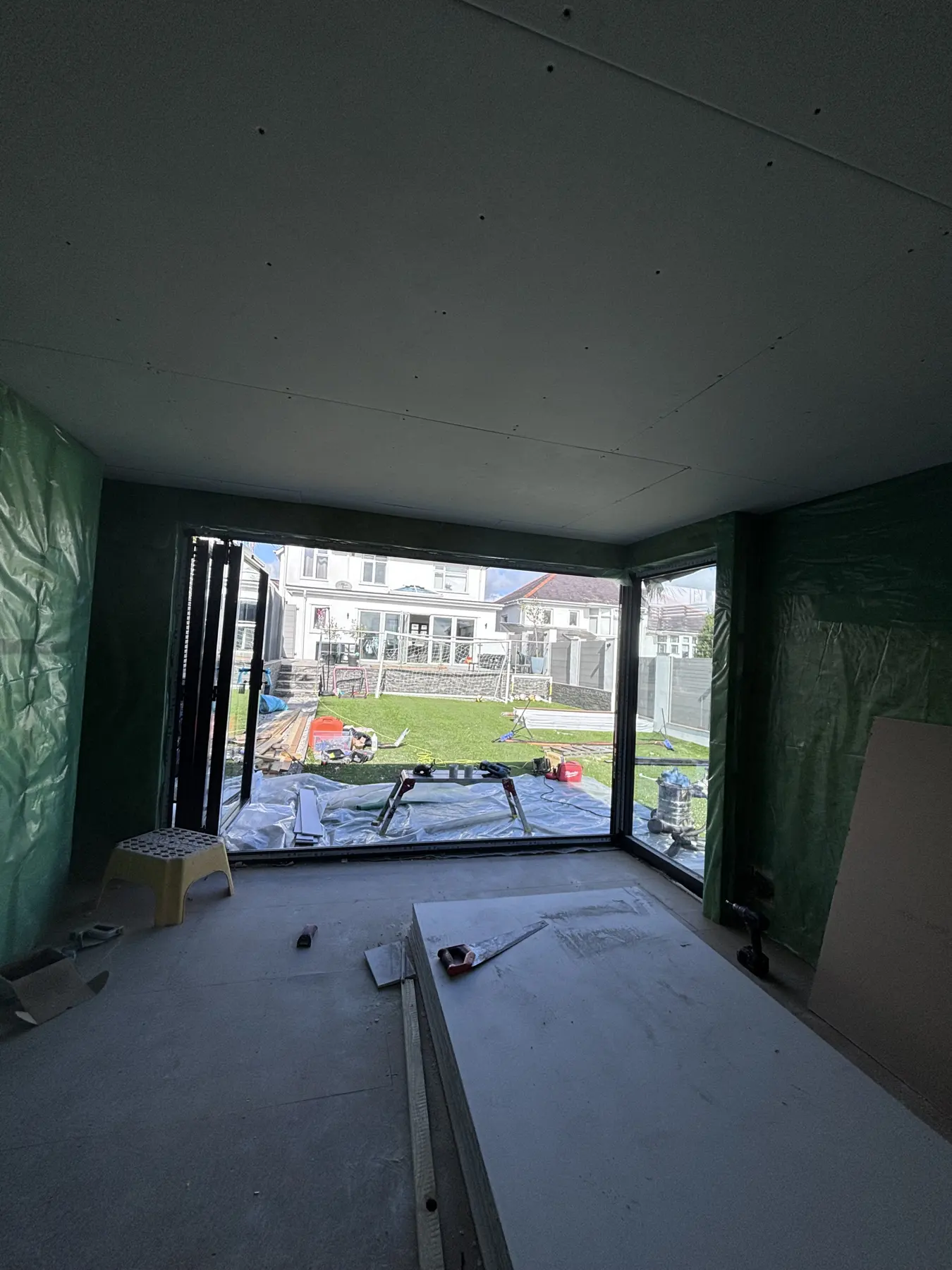

Ceiling complete

With the ceiling finished, the wall boards follow — the room starts to read as a real interior.

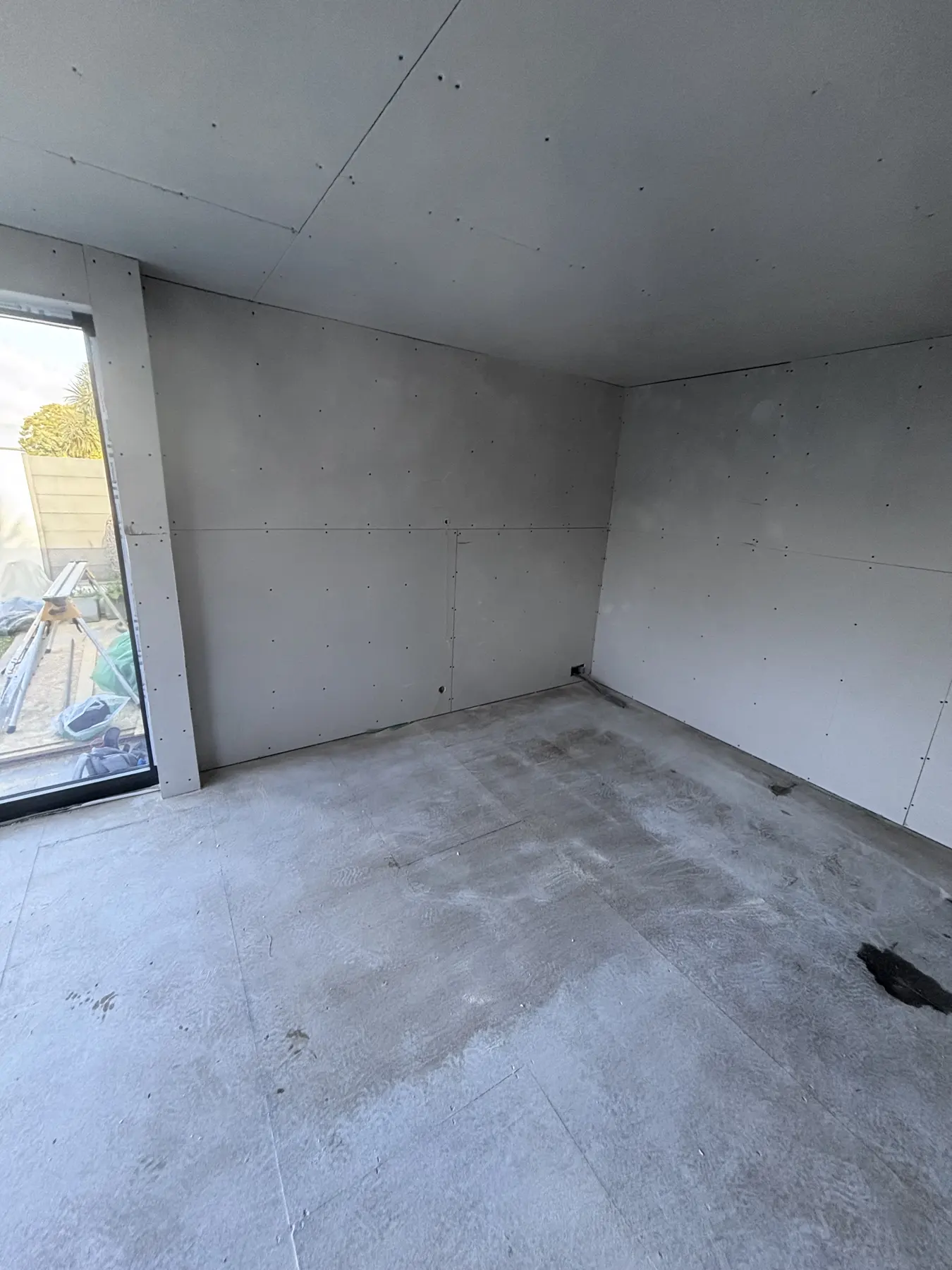

Walls boarded

Walls are boarded floor to ceiling with tight, straight joints, ready for taping and skim.

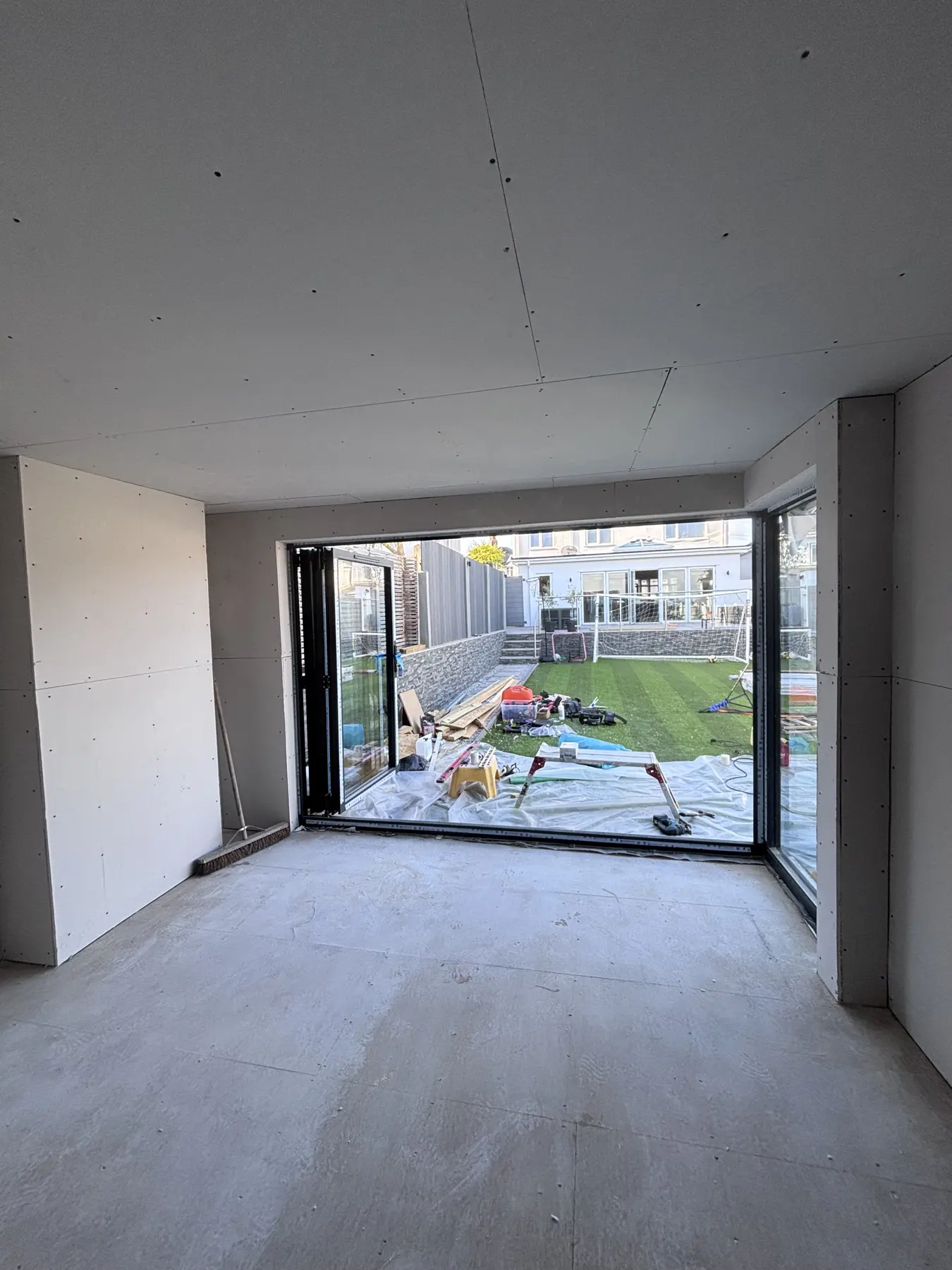

Boarded out to the glazing

The boarding is returned neatly into the glazing reveals, framing the view down the garden.

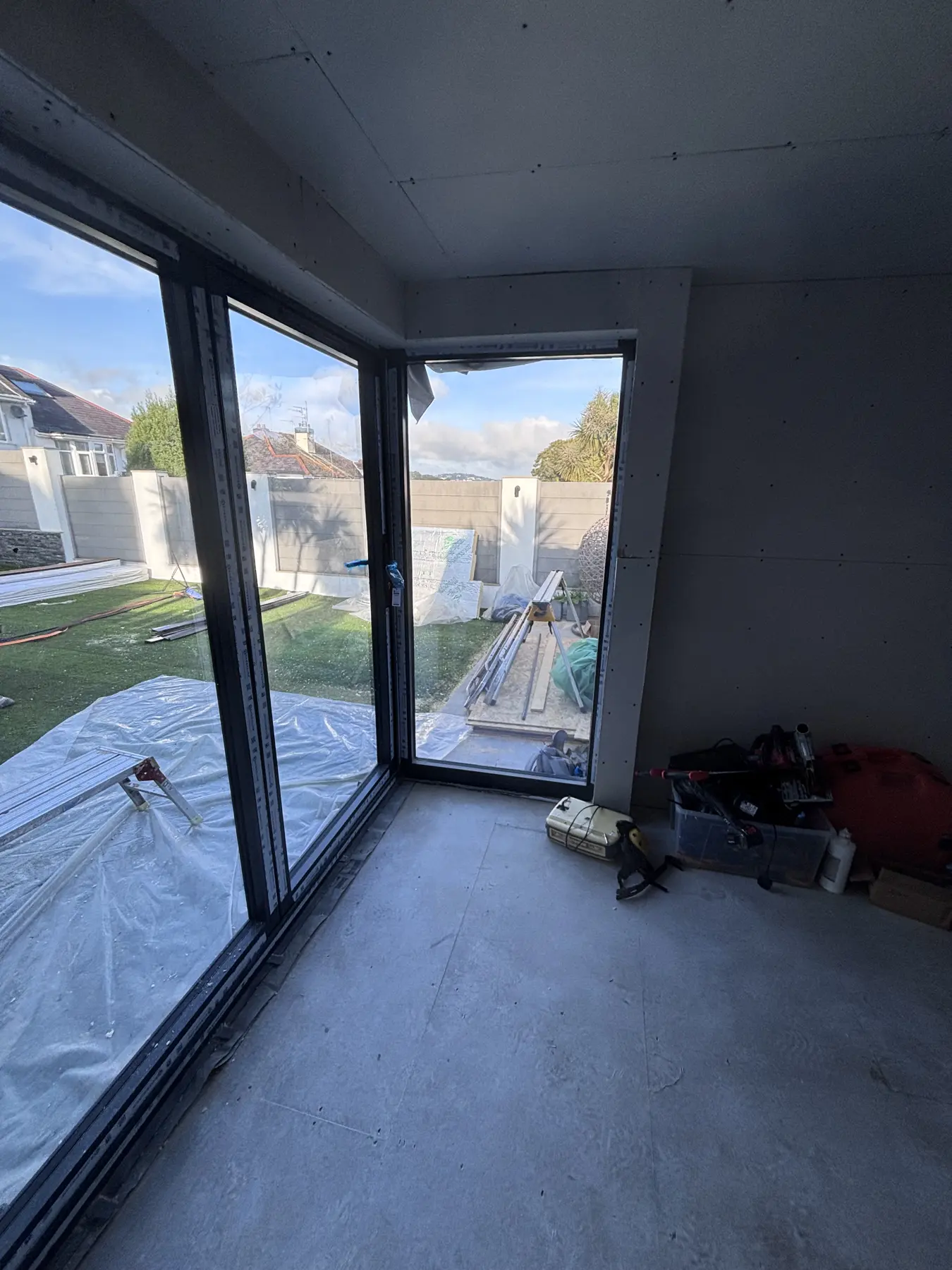

Ready for plaster

Fully boarded and ready for a hand-skimmed plaster finish — the next stage is plastering, decorating and fit-out.

Stage 07

Cladding & exterior

Outside, the battened frame is finished with roof trims and vertical cladding, fixed over the ventilated cavity so the walls can breathe.

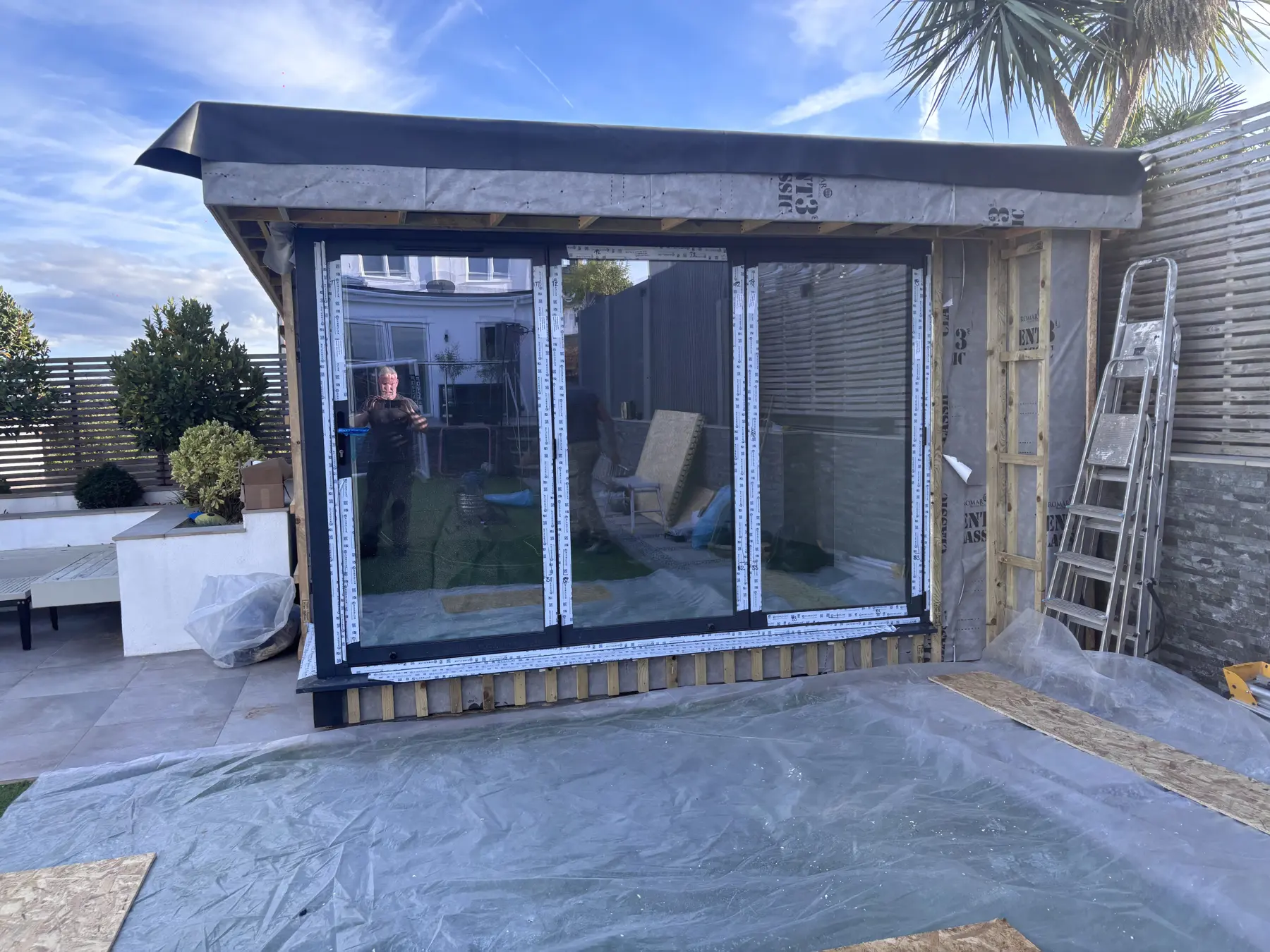

Weathertight & battened

From the garden: glazing in, breather membrane and battens on every wall, and the roof edge ready for its trims.

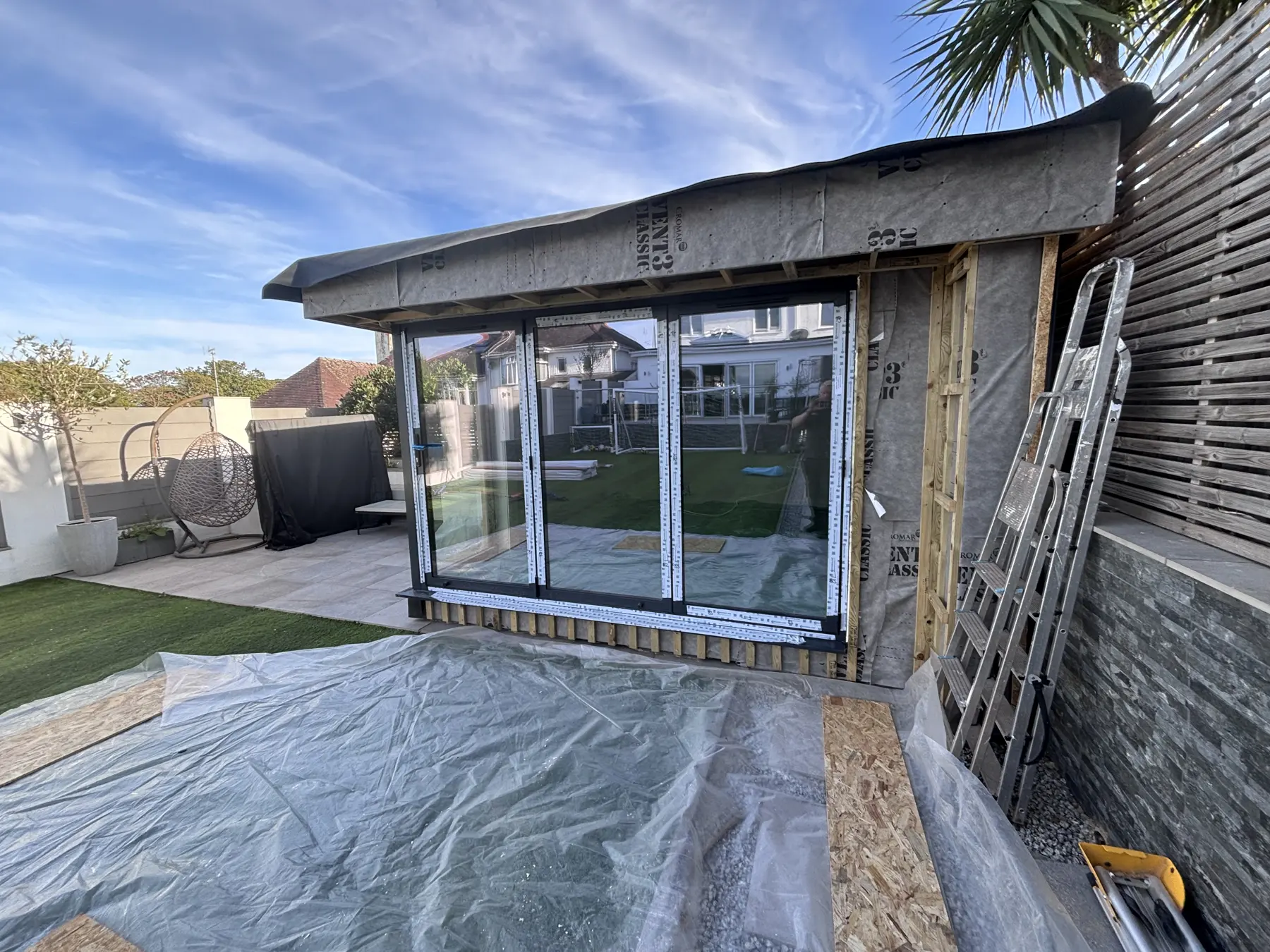

Roof edge & fascia

The roof edge is built out and dressed, giving the deep, crisp fascia line the finished room is known for.

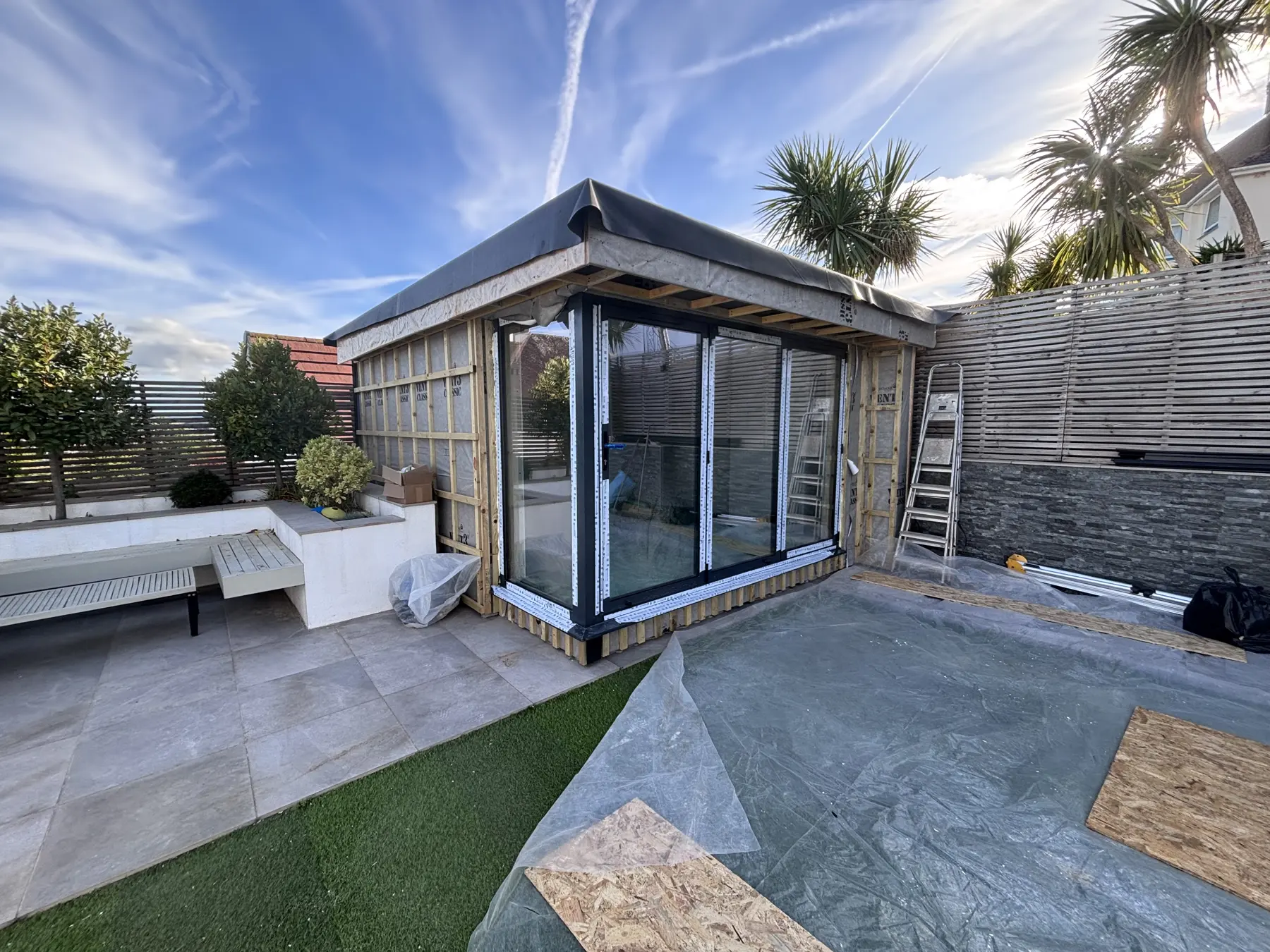

Cladding begins

Vertical cladding goes on board by board, starting from the corners and working across each elevation.

Exterior complete

Fully clad, trimmed and cleaned down — the garden room as the neighbours see it.

Stage 08

Plaster, electrics & flooring

Inside, the boards are skimmed and painted, lighting and sockets go live, and the floor finish is laid — the room becomes a room.

Skimmed, painted & lit

Walls and ceiling are hand-skimmed and painted, with the recessed downlights fitted and working.

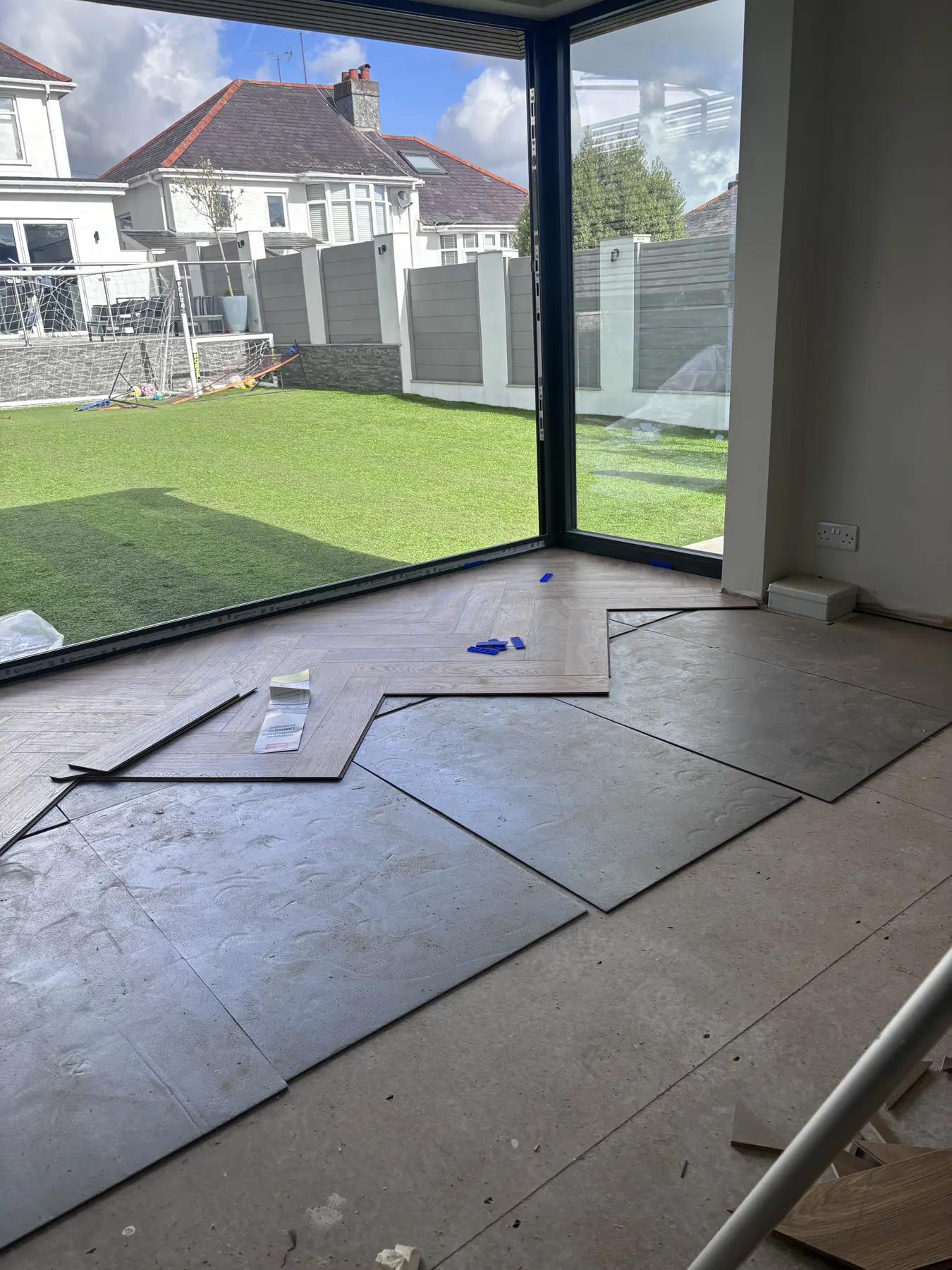

Underlay down

Underlay is laid across the deck and the first rows of herringbone are set out square to the glazing.

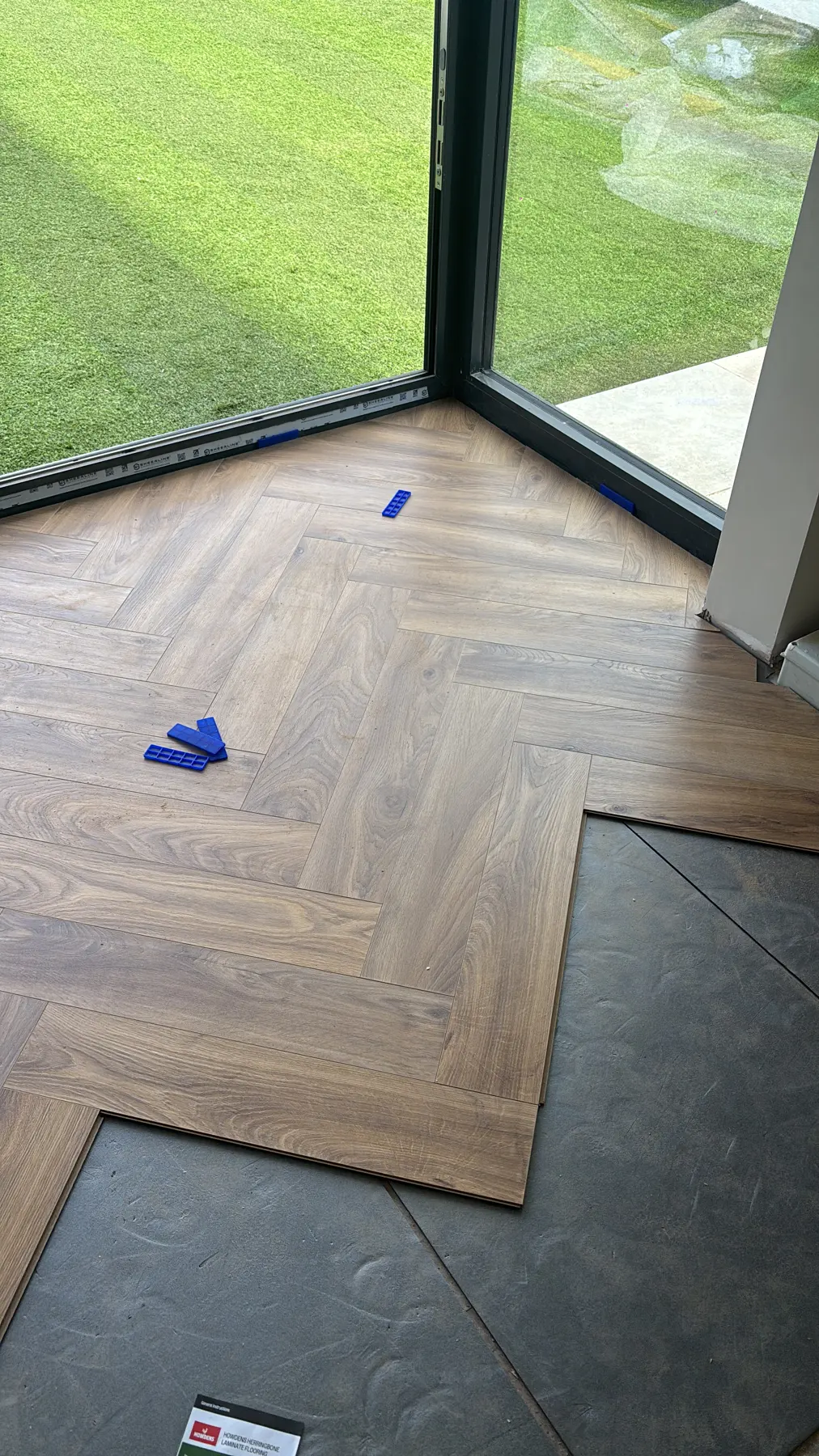

Herringbone going down

Each herringbone plank is cut and fitted by hand, running cleanly into the corner glazing.

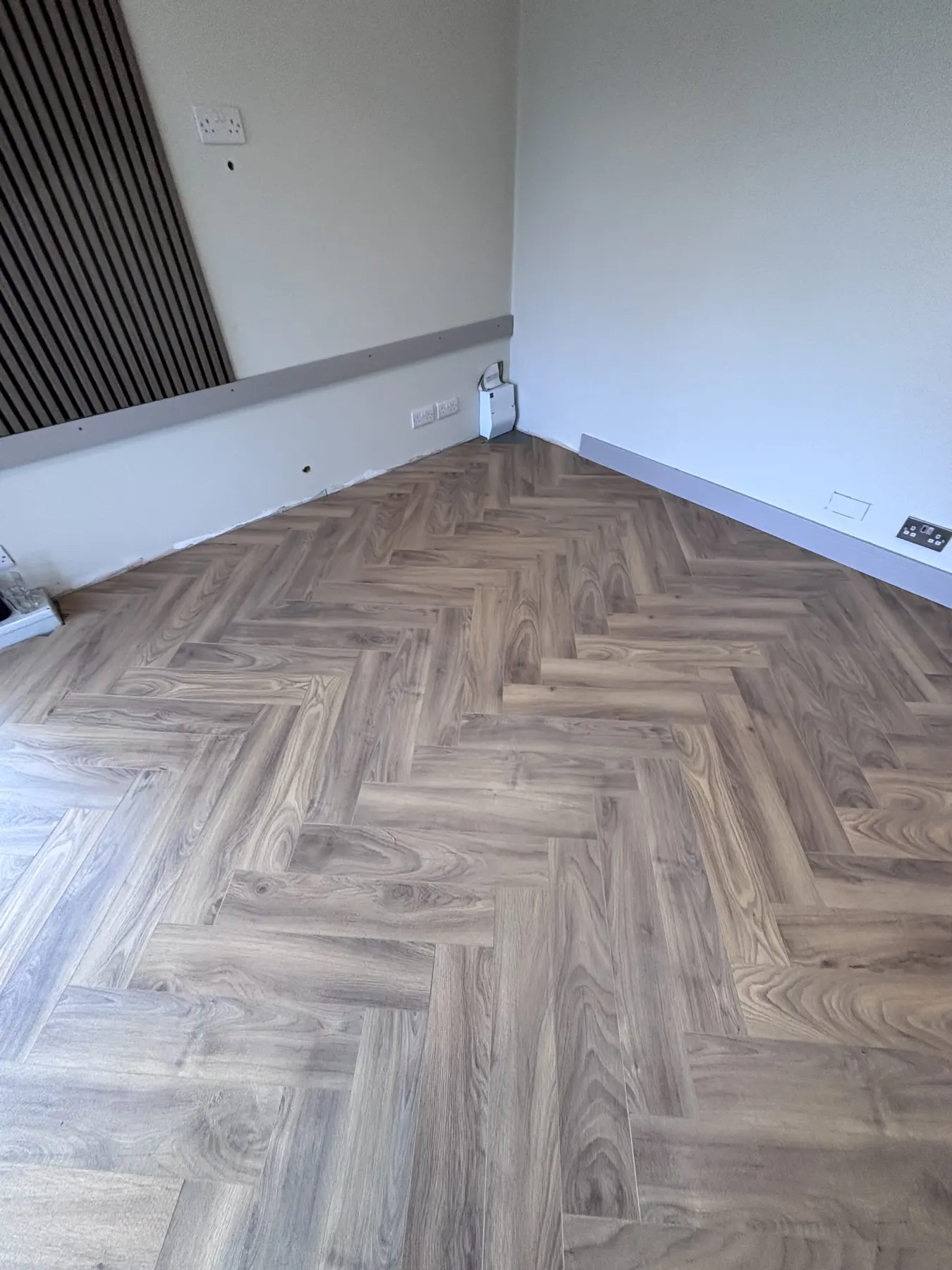

Slatted feature wall

A dark slatted feature panel is fitted to the media wall, with sockets and data points ready for the TV.

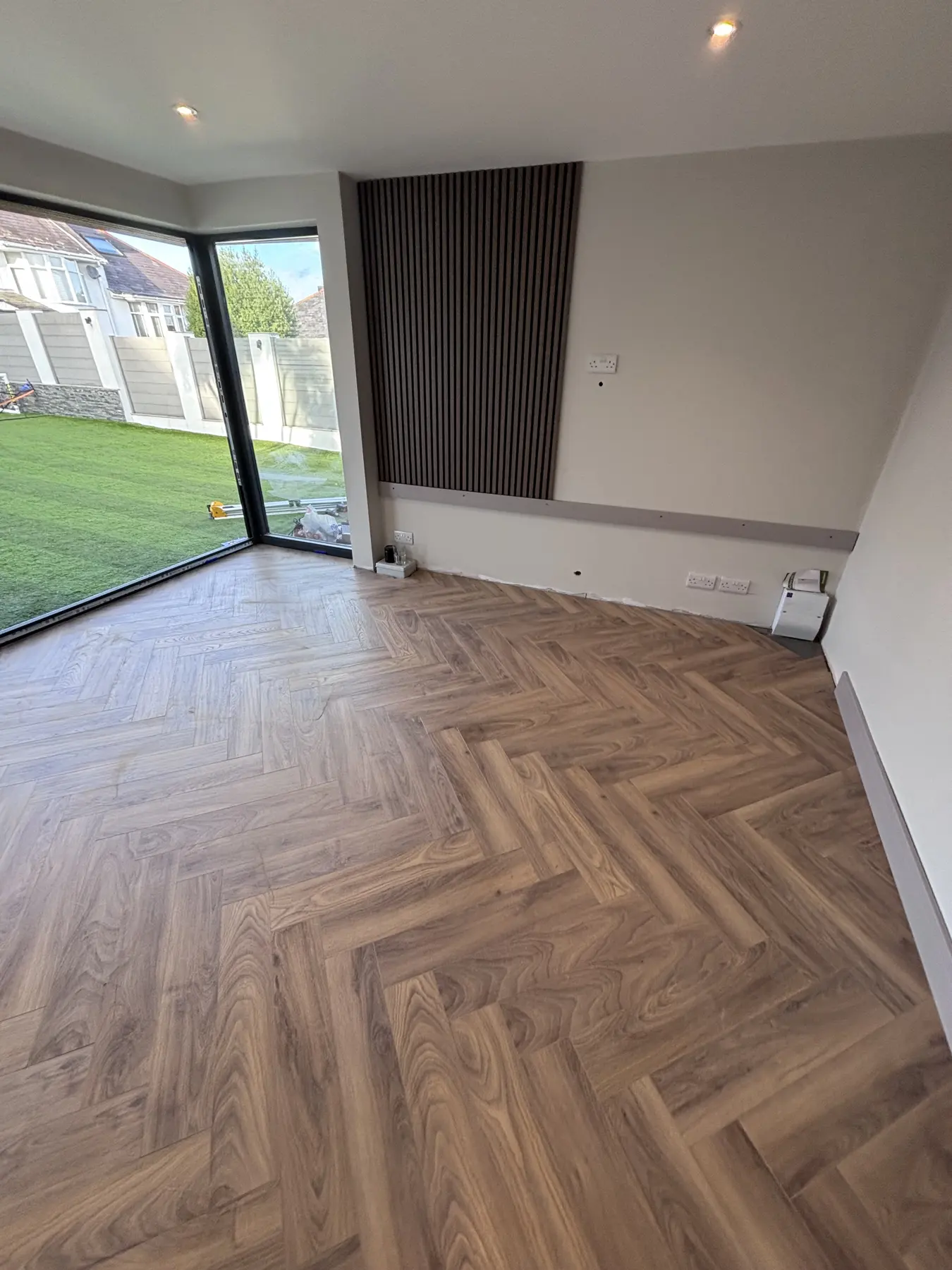

Floor complete

The herringbone floor is finished wall to wall, with skirting fitted around the room.

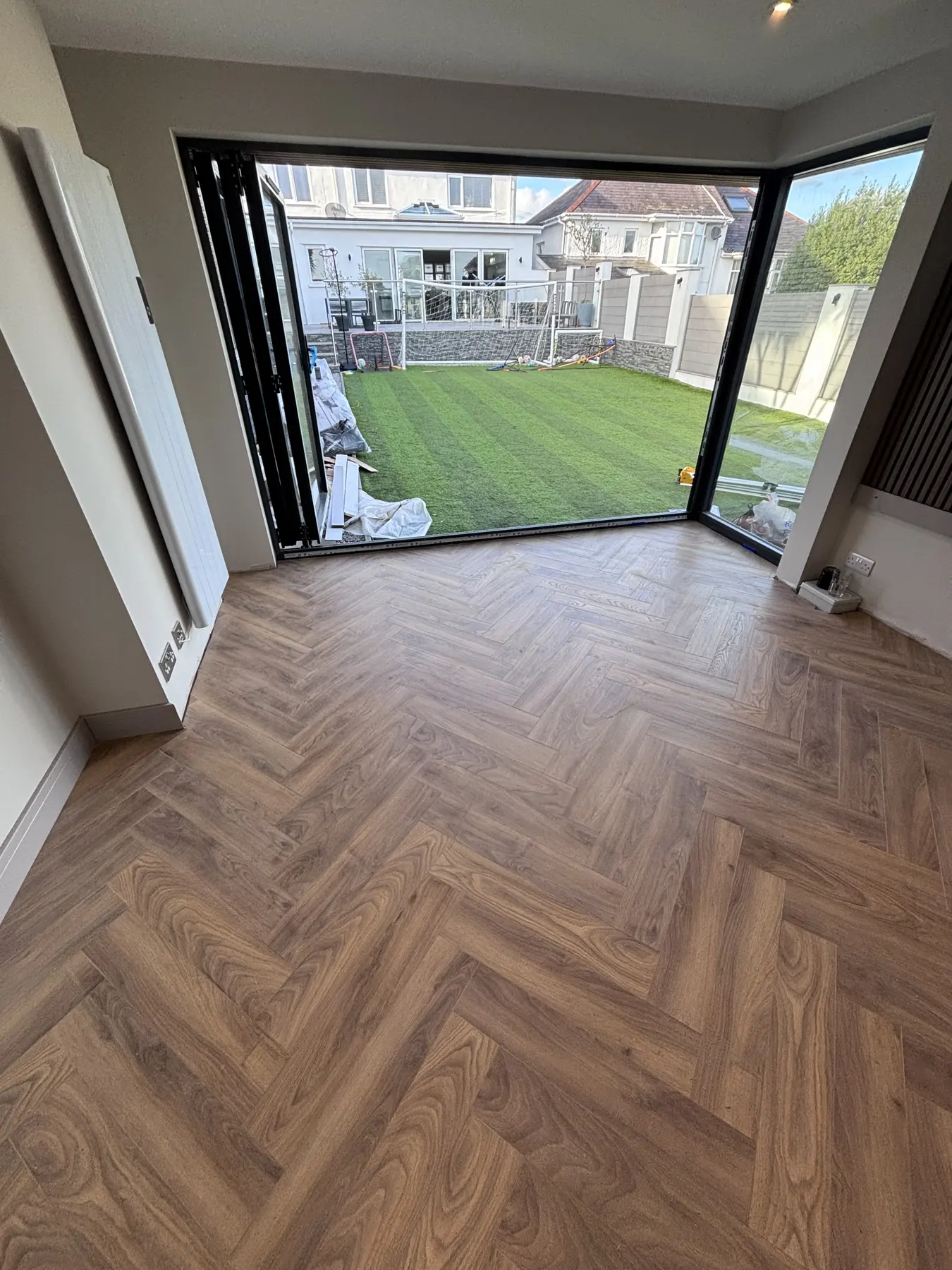

Ready for furniture

Glazing opened up, floor down, walls finished — ready for the client's furniture and fit-out.

Stage 09

Handover

Two weeks after setting out on a bare patio, the finished garden room is handed over — furnished, warm and ready to use.

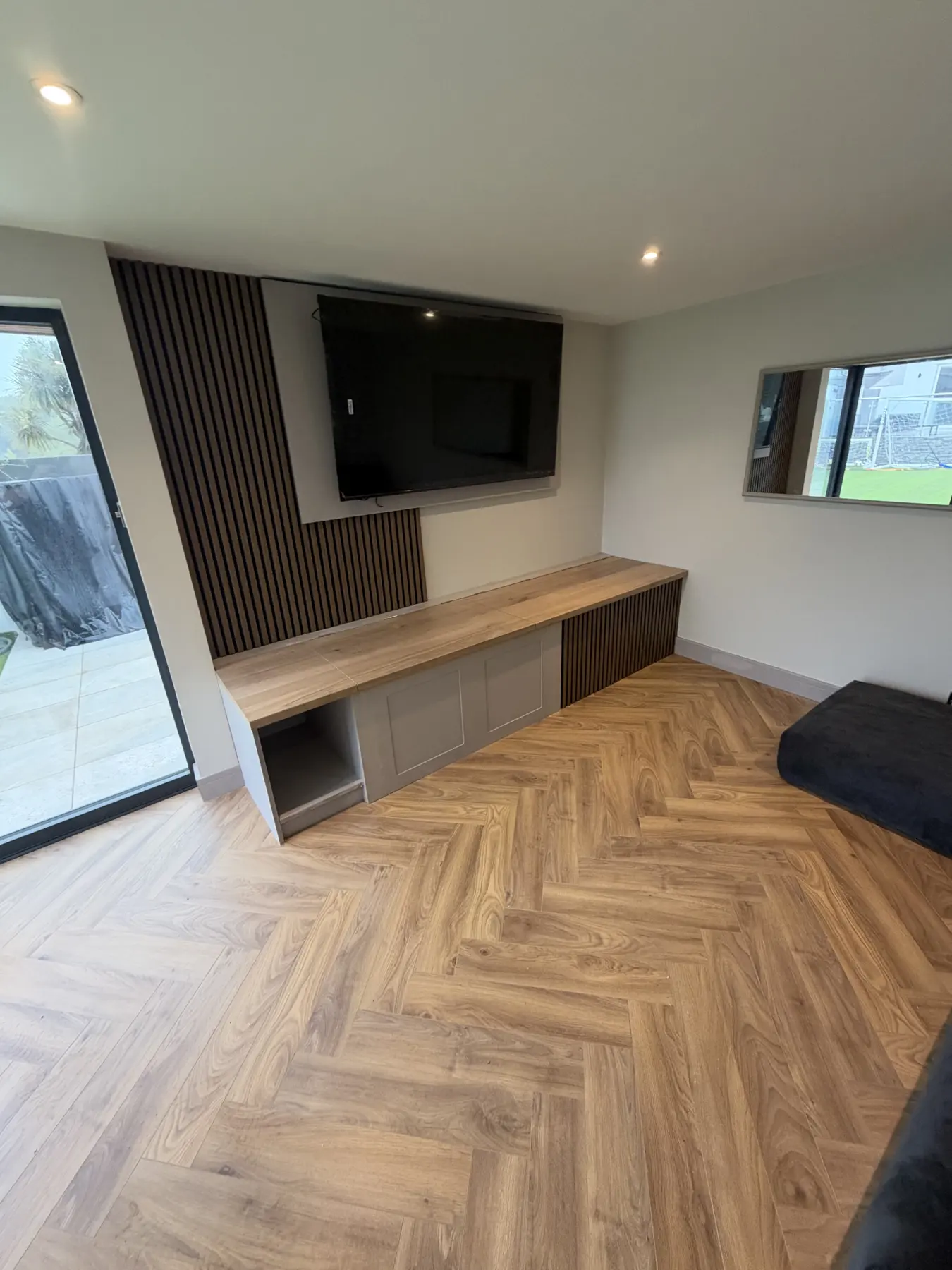

The media wall

A built-in media unit beneath the slatted feature wall and wall-mounted TV, with corner glazing on to the garden.

The lounge

Sofa, vertical heater and full-height sliding doors — a calm, warm room for every season.

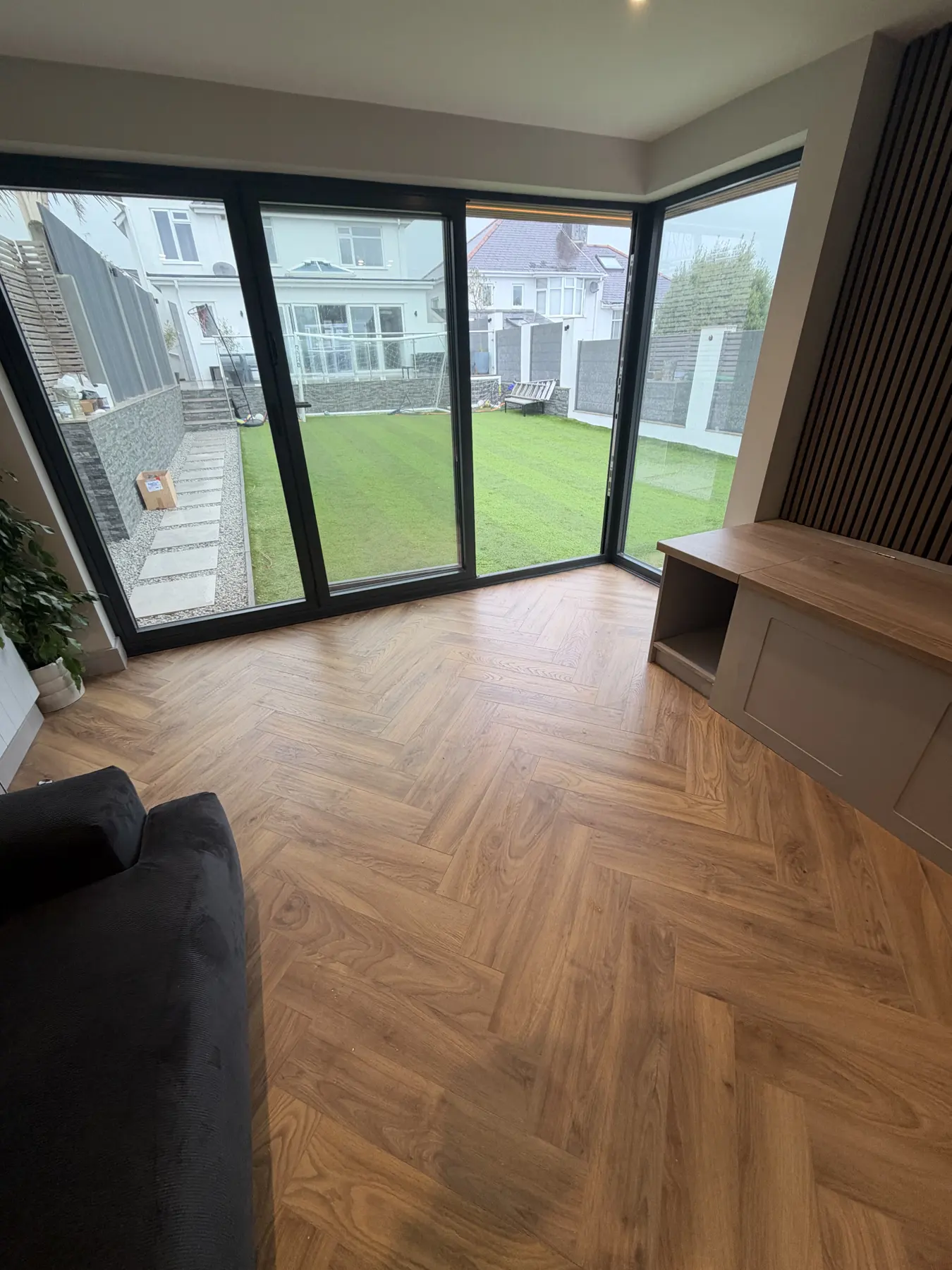

The view back to the house

Floor-to-ceiling corner glazing frames the garden and the house beyond. Handed over and ready to enjoy.

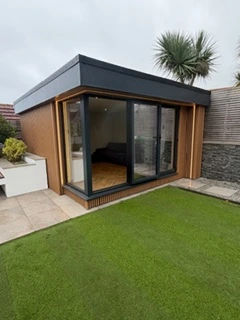

The finished garden room

From a bare patio to a fully finished, insulated garden room in two weeks — warm timber-look cladding, a crisp anthracite fascia and the corner doors open on to the lawn.

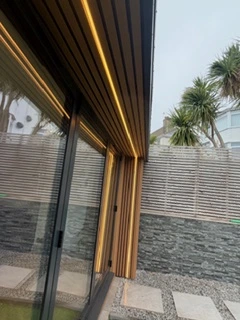

Lit slatted soffit

Warm LED strips run through the slatted soffit and down the reveal, picking out the roofline after dark.

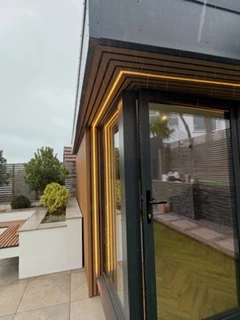

Glowing door reveal

The lit reveal frames the entrance and the herringbone floor inside — the finishing touch on handover day.

Stage 10

After dark

The same room at night — LED-lit soffits and reveals trace the roofline, and the glazing turns the whole room into a lantern at the end of the garden.

Lit corner glazing

Warm LED strips outline the slatted soffit and corner reveals, with the lounge glowing through the glass.

The front at night

Full-height glazing across the front shows off the media wall and mood lighting inside.

Doors open to the garden

With the doors folded back, the room opens straight on to the lawn — made for summer evenings.

At the end of the garden

Seen down the lit stepping-stone path, the room sits neatly beside the illuminated seating area.

The view from the house

From the house, the garden room finishes the garden — a warm, lit destination all year round.
